The wood floor finish is completed. The storefront system is complete. The ramp and stair handrails are complete. Punchlist and fire alarm work is taking place. The project is substantially complete.

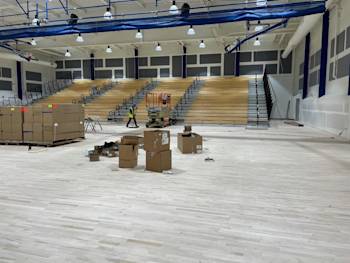

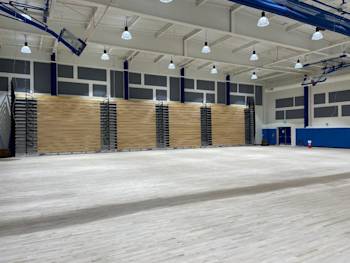

The bleachers are complete. The wood floor sanding and finishing is beginning. The lobby concrete floor is complete. The gym audio/visual is complete.

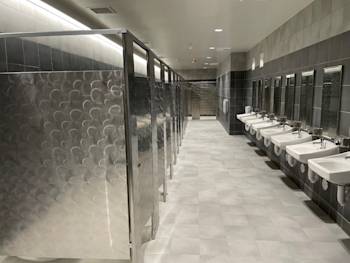

The bleachers are currently being installed. The glass for the storefronts are being installed. The doors for the storefronts are being installed. The sidewalk in the east lot was removed and replaced. The AV system is being installed.

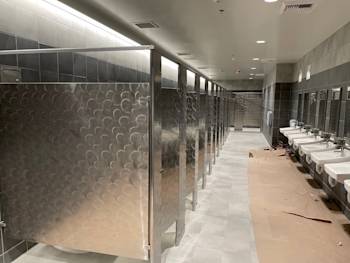

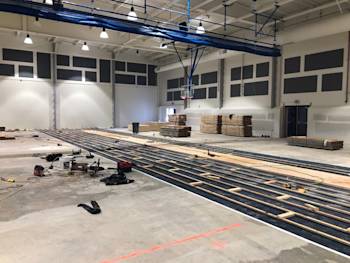

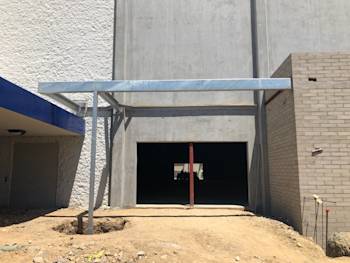

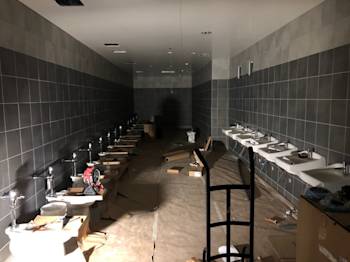

The gym equipment in the gym was installed and completed. The wood flooring is starting. The restroom tile was installed and complete. The restroom finishes are starting. The lobby corridor drywall was hung, taped and complete. Paint is starting. The exterior concrete is poured and complete. The exterior railings were measured and being fabricated.
The gym equipment in the gym was installed and completed. The wood flooring is starting. The restroom tile was installed and complete. The restroom finishes are starting. The lobby corridor drywall was hung, taped and complete. Paint is starting. The exterior concrete is poured and complete. The exterior railings were measured and being fabricated.

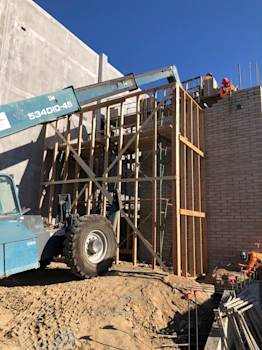

The fire rated wall in the wood shop is installed and complete. The west classroom new fire rated wall is complete. T-bar and flooring are complete and room is ready for turnover. The locker room new seperation wall is framed and locker room plaster patch back is complete. The boys and girls restrooms walls are framed and and the in-wall utilites and over head utilities are being isntalled. The gym overhead utilities are complete and lower walls are being installed.
The fire rated wall in the wood shop is installed and complete. The west classroom new fire rated wall is complete. T-bar and flooring are complete and room is ready for turnover. The locker room new seperation wall is framed and locker room plaster patch back is complete. The boys and girls restrooms walls are framed and and the in-wall utilites and overhead utilities are being isntalled. The gym overhead utilities are complete and lower walls are being installed.

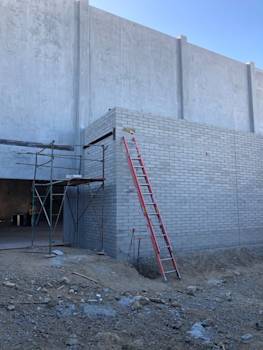

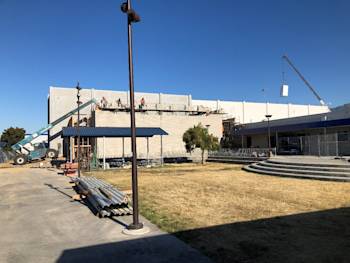

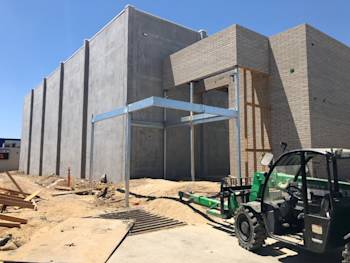

The CMU walls on the east and west are complete. The structural steel was installed at the CMU. The roofing on the main gym started and completed. Sprinkler lines in the locker rooms are complete and the plaster is patched back. The structural steel beam in the west classroom is complete and fireproofing in the classroom and wood shop is complete. Overhead utilities are 90% complete. The locker room roof curbs were installed. The new boys and girls restroom slab was poured. The HVAC units for the main gym and boys locker room were installed.

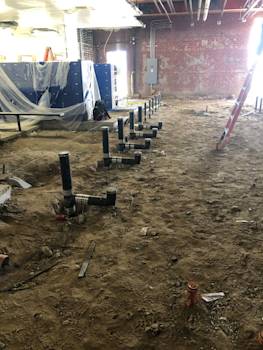

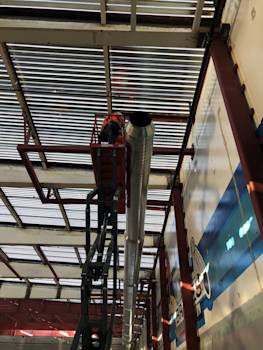

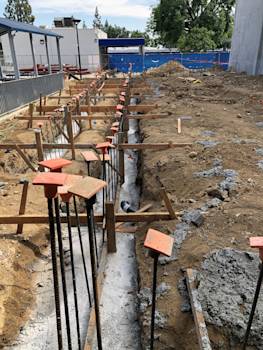

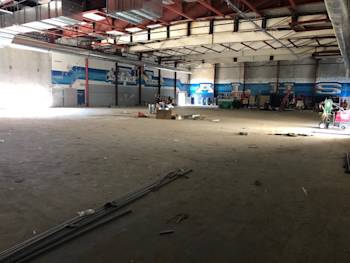

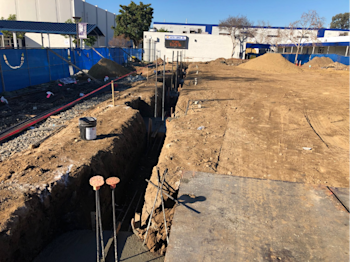

The footings for the east and west rooms were poured. The CMU walls are progressing this month. The HVAC roof curbs have been installed. Deck inserts are complete. All overhead utilities are currently being installed in the gymnasium. The overhead sprinkler lines in the locker room are near completion. The demolition of the west classroom is complete.

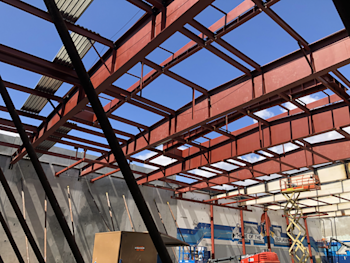

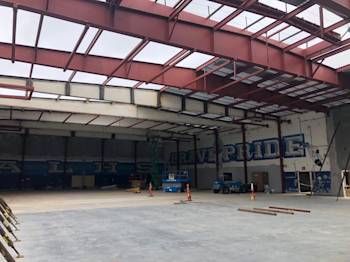

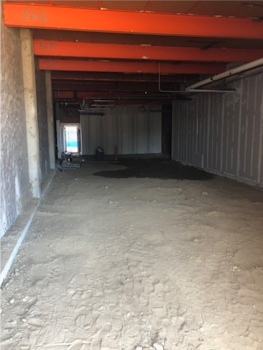

General fit up and welding of the structural steel is complete. Metal decking is complete on the high roof. Underground utility work is complete for the rooms on the east and west of the gym. The footings for these rooms is dug and rebar is currently being installed. Demolition in the locker rooms has started.
Concrete stitch columns were poured and stripped. Structural steel members were received and hung. Iron workers continue to bolt and weld up the members to the structure. Grading is taking place on the outside of the building for the rooms on the east and west sides. Electrical contractor mobilized to begin underground in the gang restrooms west of the locker rooms. The new small gym HVAC units were replaced on the small gymnasium.

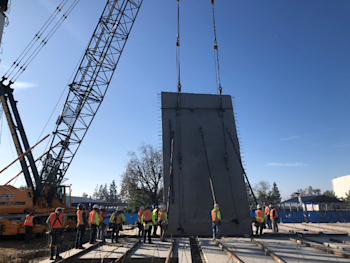

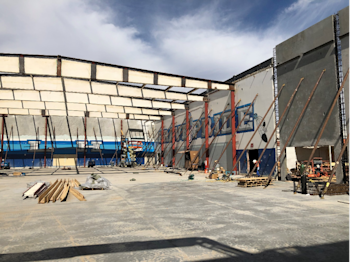

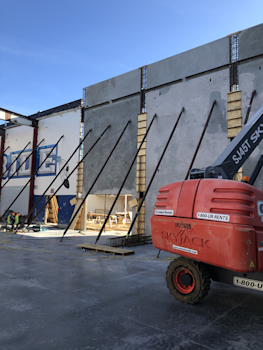

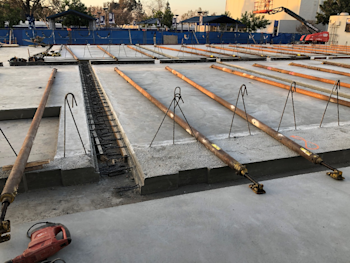

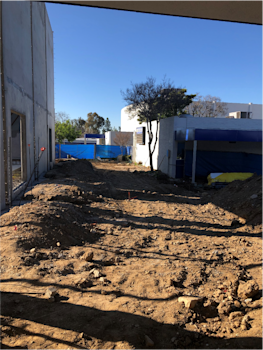

The tilt up walls were formed and poured. The walls were craned into place. The rebar is currently being placed in the stitch columns and they are being closed up with form work. New columns are being placed under the existing girders.

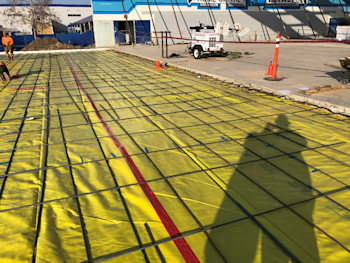

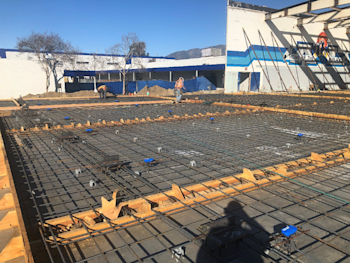

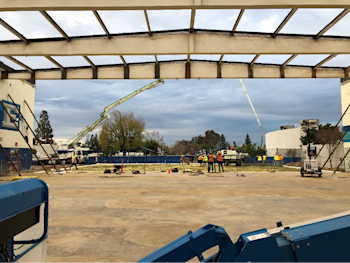

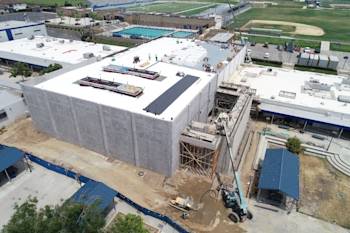

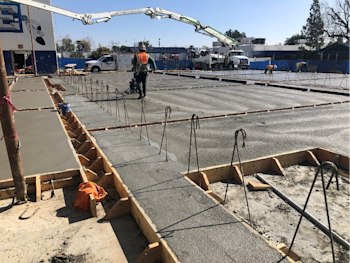

The footings for the new gym walls have been poured. The electrical conduit under the slab were installed. The slab on grade for the new gym has been poured. The concrete tilt up walls have been formed and rebar has been placed in the form work. Structural steel is currently being fabricated for the gym.

The south wall of the existing gym is completely demolished. All rubble has been removed from the jobsite. The new pad is graded and certified with the rain days. The underground sewer lines in the boys locker room are complete. The fire hydrants are installed in the east parking lot and they are workinng on backfill.

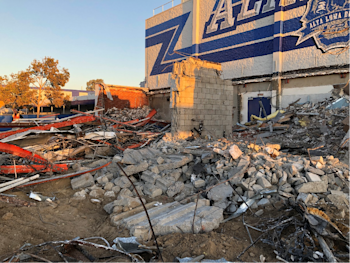

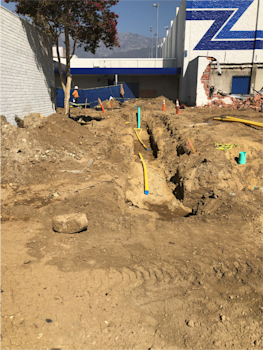

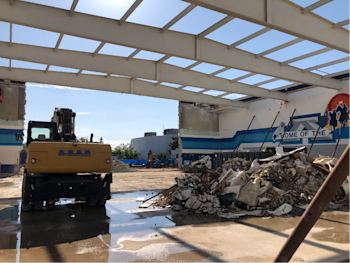

The roof demolition is complete and rubble is almost complete from being removed. The south wall is 80% demolished. All MEP systems have been demolished from the interior of the gym.The gas line has been rerouted out of the gym and over to the small gym. The back road asphalt patch is complete where the new fire water and electrical was placed.

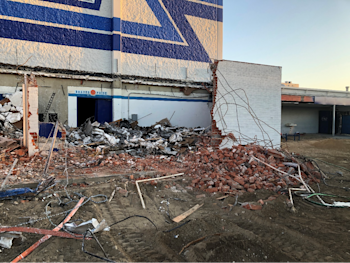

The storm drain, water and gas line in front of the new gym have been re-routed out of the way of the new building. The fire water line on the back fire road has been installed and the Fire Department Connections has been installed and backfilled. The existing gymnasium bathrooms have been demolished. The gymnasium bleachers, basketball hoops and wood floor have been demolished. The roof is currently being demolished.

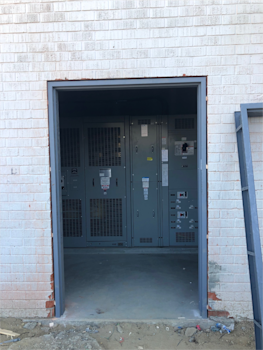

The electrical relocation portion of the project required to start the demolision finished first week of September. The power was successfully transferred to the new electrical room. Demolition began on the shade structures in the quad. The plumber has mobilized onsite to begin cutting and capping existing lines and start the utility relocation activity.
