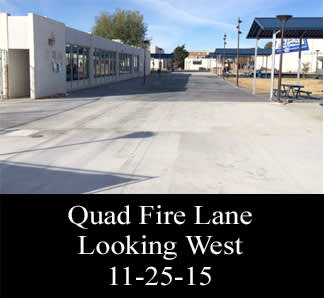

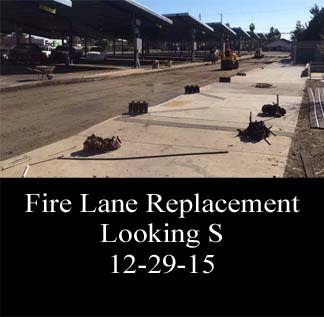

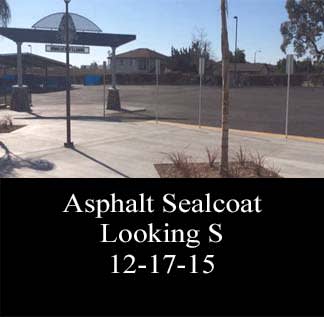

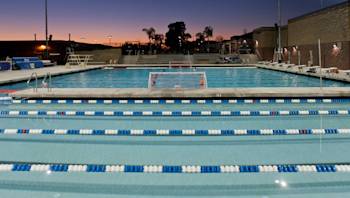

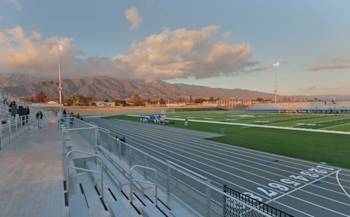

During the month of December 2015, the track and field was turned over the school to be used for the boys soccer game, the site work was completed, final lift of asphalt was placed, seal coat done, and the Fire lane was completed. All gates were installed and the final cleaning was completed.
During the month of November 2015, the track was completed, the fire alarm system for the entire site is completed and the security system is completed. All site concrete and landscaping was completed and the gates for the site are being installed. The final lift of asphalt was placed and the parking lot signs were installed. All exterior paint is completed. The buildings are completed and punchlist is in progress.

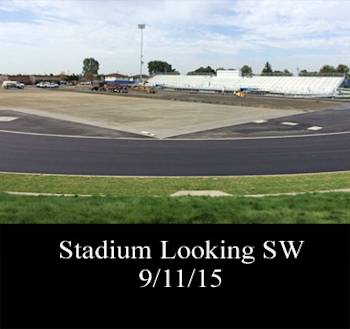

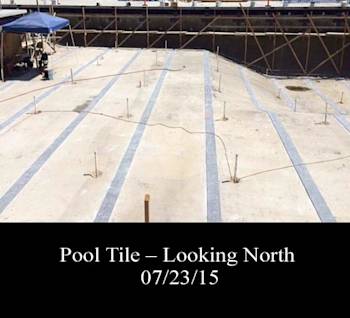

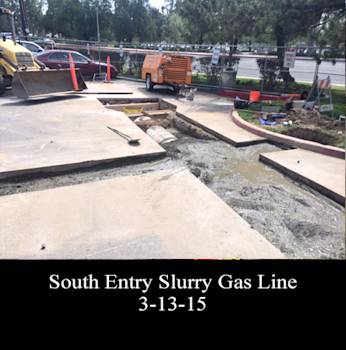

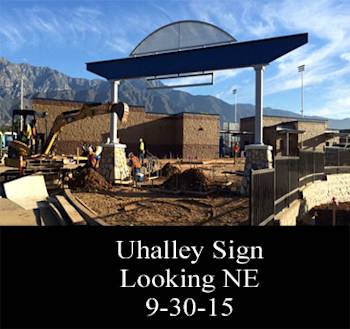

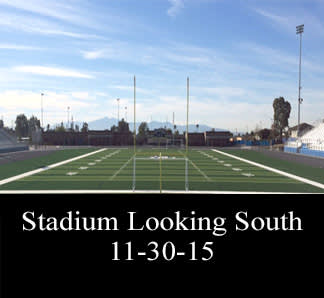

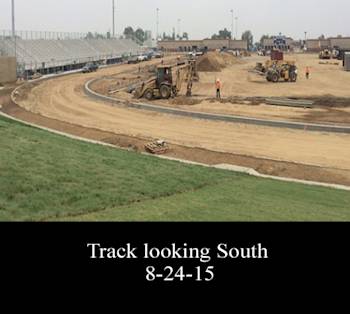

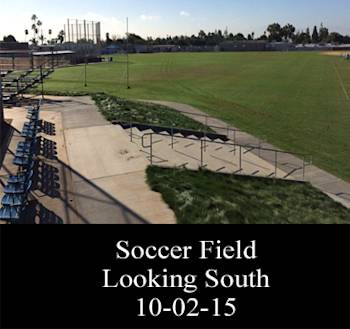

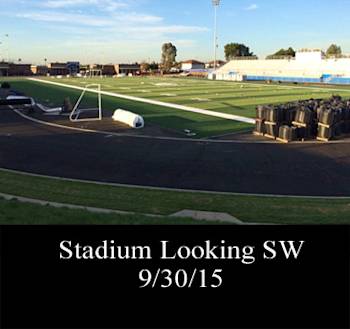

A formal dedication of the field occurred on October 27, 2015. The synthetic turf is complete and the final lift for the track is finishing up. Striping of track is scheduled in November. The site concrete, and entry plaza concrete is complete, trees are installed, trash cans, bike racks and entry sign, building signs, interior signs and site lighting is installed. All plumbing and electrical finishes for the Home Building (M), Visitor Building (P) and Concession Building (N) has been completed. All kitchen equipment at Concession Building (P) has been installed and is being hooked up. Air balancing for all building is being completed. Resilient tile flooring installation is starting at Home and Visitor Building. Bleachers are complete and final painting is being done. Grounds Building is officially occupied. The fire lane at the quad is being installed.
General: The Main Quad area was turned over to School in time for their Home Coming. The track and field area was graded, base was placed, drainage was installed and Asphalt surfacing for the track and D zone was all installed. The Synthetic turf is nearing completion. The Home/Pool Building (M) partitions for the restroom are installed, concrete floor was sealed, all HVAC is up and running, Fire alarm and security is being finalized at the pool. The Concession Building (N) epoxy flooring is done, electrical finishes are installed. The Visitor Building (P) ceramic tile at the restroom is installed, partitions at the restrooms are being installed, the walls are painted, lighting and electrical finishes are installed, and the HVAC equipment is being started up. The Grounds building (R) is completed and the District has put some equipment in the building. The main entry plaza concrete has all been installed, entry structure is installed, tree wells are installed and light poles are going in. The overall site concrete North of the buildings is progressing.
General: The Baseball Varsity field sod is now established. The HVAC ductwork and units for all buildings were installed. The Grounds building has been completely painted and ready for final finishes. The Stadium bleachers are being completed with the finish façade going on. The field cooling system is installed. The track asphalt base is completed. The pressbox sound system and speakers are being installed.

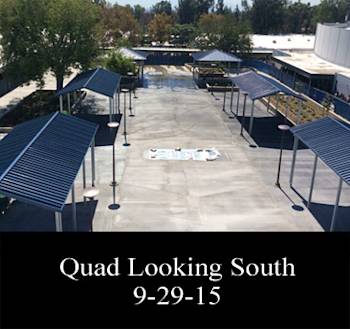

Phase 2 Quad: All shade structures are completed, landscaping has been installed. Added ramp is being completed and the flatwork is being installed.

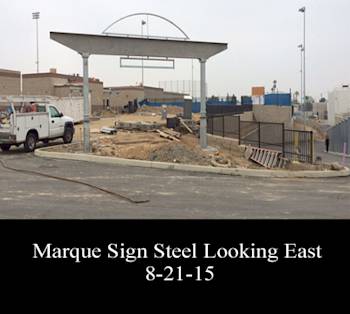

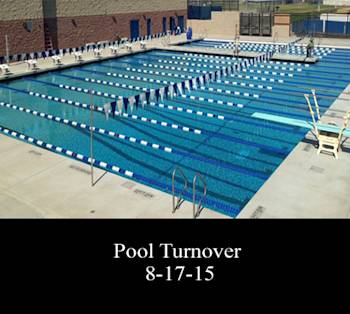

New Pool: The pool was turned over to the school on 8/17/15 and is in use.
Existing Varsity Field: The existing Varsity field sod is established and the added conduit is completed. This field is ready for turn over to the school.
Stadium/Site: The stadium bleachers are being completed with all finish trim.
General: At the Visitor’s Building (M Bldg.) the roof was completed, interior walls have been taped and primed, staff restrooms have been tiled, fire alarm is being installed and the fire sprinkler is installed. The pool equipment is all installed. The Concession Building (N) and the Home Building (P) all deck is installed, walls are being framed, drywall is hung, door and hardware is installed, fire sprinklers are all installed. Ground Building (V) deck and roof is installed, doors and hardware is installed, walls are framed and drywalled, and the finishes are going in.

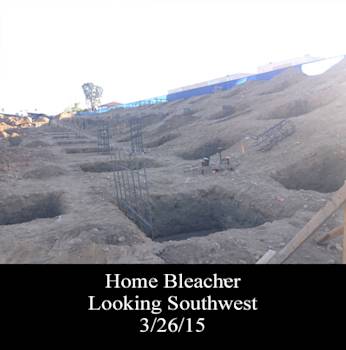

Phase 2 Quad: All planter wall are installed and waterproofed, the concrete ramp is progressing, all added ADA path of travel changes are completed, and (2) shade structures are installed.

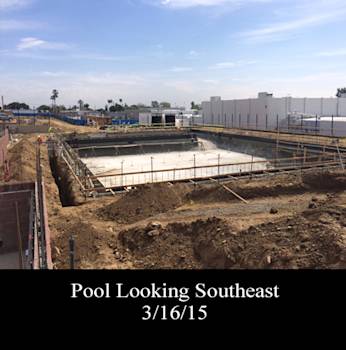

New Pool: The pool deck is completed, pool plaster is completed and the pool is being filled with water.

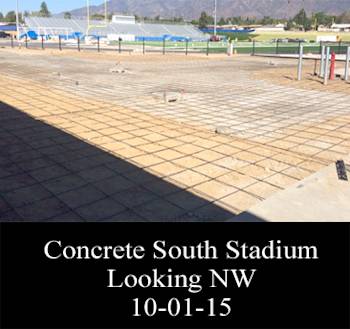

Stadium/Site: Fields are all complete, including changes to the backstops. The stadium cooling system is completed, bleacher seats are all installed and the press box is set. Asphalt paving of parking lot and fire lane has started.

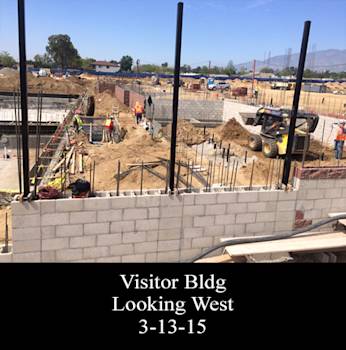

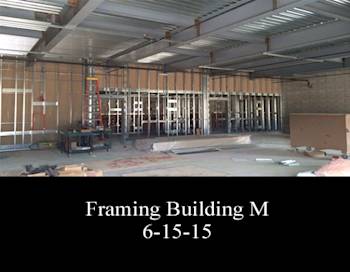

General: At the Visitor’s Building (M Bldg.) interior walls were framed and drywall was installed, roll up door and pedestrian doors are installed, window opening and stainless steel countertop are installed, main electrical panel and the pool equipment is installed and overhead utilities have started. At the Concession Building (N) and the Home Building (P) all block is completed, doors are being hung and the rough in utilities are being completed. The Ground Building (V) the roll door installed and all utility rough in is complete.
Phase 1 Quad: Complete and turned over to the school
Phase 2 Quad: Demolition is done and rough grading is complete. Storm drain line is completed and the new ramp per the ADA upgrades has started.

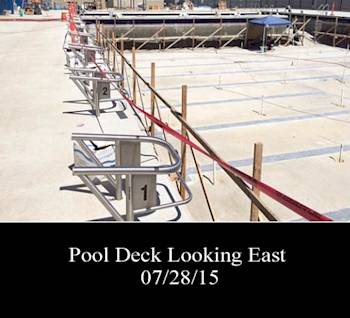

New Pool: The main gutter for the pool was installed, remaining underground utilities for the pool deck was installed, the peninsula and half of the concrete deck for the pool is completed.

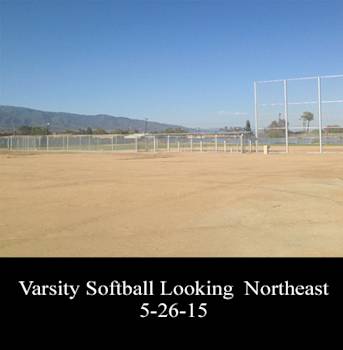

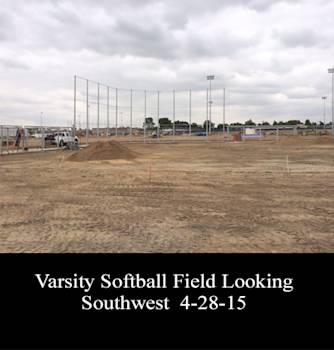

Existing Varsity Field: The existing Varsity field has been graded, and main irrigation lines are installed.

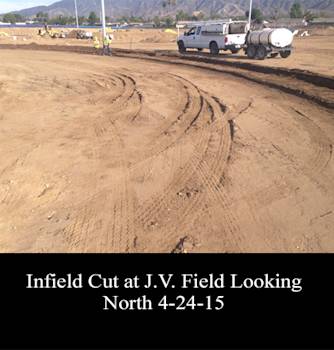

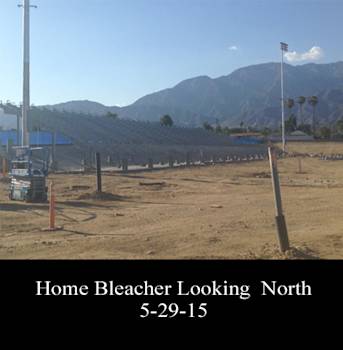

Stadium/Site: All sod at the fields has been completed; Infield is being completed at the J.V. field. Home and Visitor bleachers are erected and floor planks are being installed. The Press box was set this month.

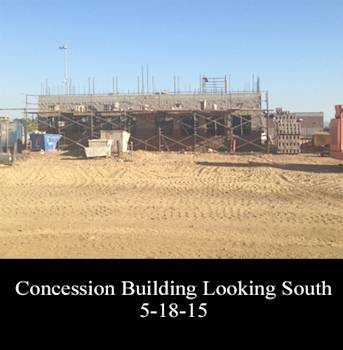

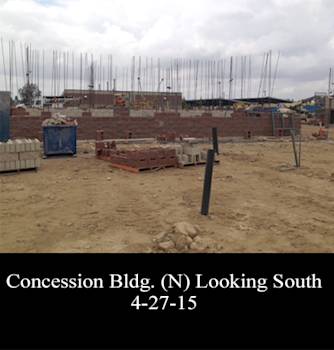

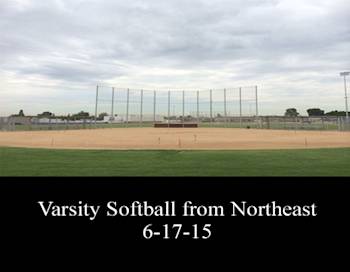

General: All the pool equipment is onsite. The Visitor/ Pool Building are fully erected, structural steel has started, and metal deck is installed. The Home building is full erected, steel is being installed and metal studs walls are being framed. The concession building is on its 3rd lift of CMU block. The sod for the softball fields is installed, dugouts are completed and the chain link fence is installed. Permanent power is up and running for the site

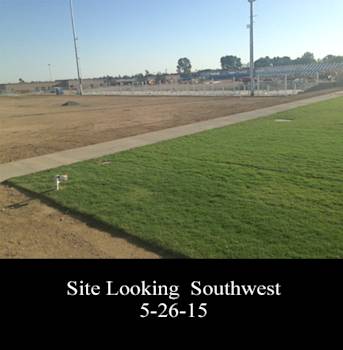

Phase 1 Quad: The Quad is completed, sod was installed, landscaping was completed and we are doing final cleaning to officially turn over to the School end of June 2015.
Phase 2 Quad: Work has started. Area was safed off and demolition has begun.
New Pool: The pool gutter is formed, tile work is continuing and, pool deck is graded and prepared, all pool equipment is onsite.
Existing Varsity Field: Started grading of the field and removed grass. Added new curb at outfield fence.

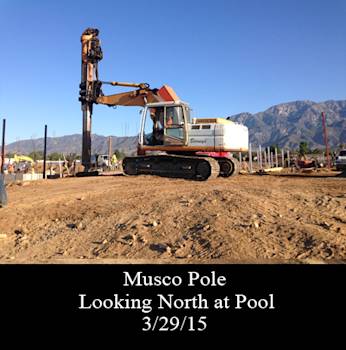

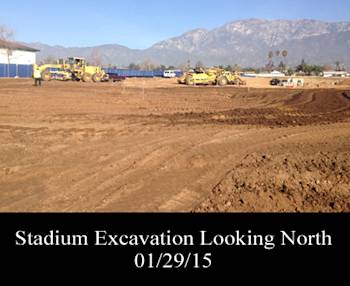

Stadium/Site: The electrical switchgear is installed, Musco panel is installed and there is permanent power to the site. The Musco poles were turned on. Bleachers steel for home and visitor is being erected.

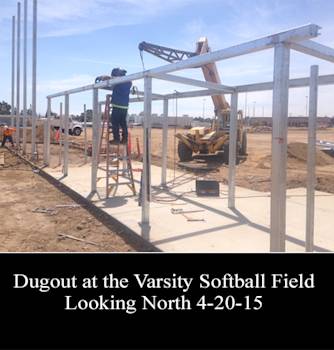

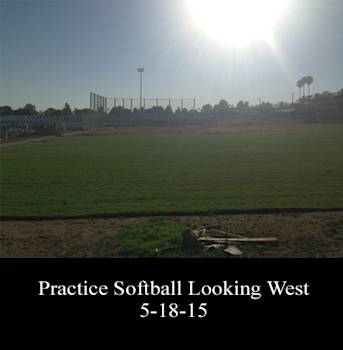

General: The new pool is currently tracking ahead of original schedule as the pool tile is being installed. Majority of the buildings are fully erected and the site is being prepared to receive sod at the end of May 2015. DG for the infields has been started, backstop posts are installed and soil is starting. The push over the next month is to prep all fields for installation for sod start to final installation of all of the athletic field equipment. The permanent power for the site will be up and running.
Phase 1 Quad: The Light Fixtures are installed and the Shade structures have been erected. Majority of the flatwork has been place and the final bit of flatwork is going to be installed in May 2015. Soil is being prepared to receive sod.

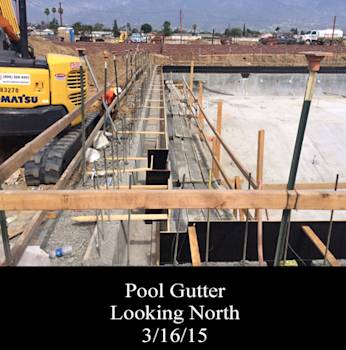

New Pool: The pool wall tile is being installed and the surge chamber is complete.

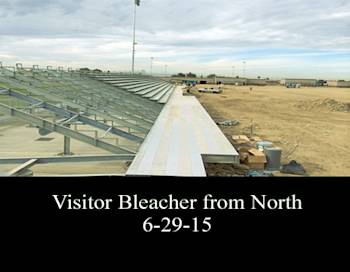

Stadium/Site: All Musco poles are erected and installed. The Home and Visitor bleachers columns are all installed and steel will be delivered in May 2015 to start erection of the bleachers. All backstop post were installed, DG for fields has been delivered, dug out roofs are being framed, sidewalks and ramps are installed, and chain link fence is being installed. Switchgear is being installed and wire is being pulled to the gear.

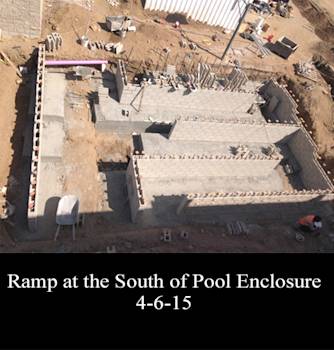

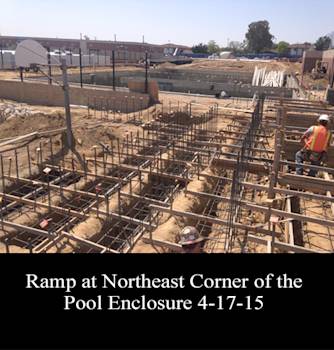

Phase 1 Quad: The raised area in the quad has been poured and preparation for setting the shade structures is in progress. All utilities have been installed in this phase. The concrete for the sidewalk has started with the forming and rebar installation in progress.
Phase 2 Quad: Work is scheduled to start after school is out.
New Pool: The pool walls have been shotcrete, the pool gutter is formed and poured and the stairs are complete. The pool surge chamber is installed.
Existing Varsity Field: Next schedule work is scheduled after school is out when the field is no longer in use by the Baseball team.

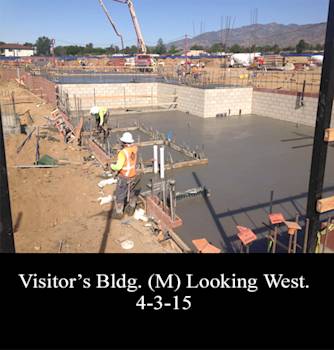

Stadium/Site: All underground for the site electrical and plumbing is complete. The main entry wall is installed. The retaining walls for the practice softball field and the varsity softball field are complete. The new pump for waterline is installed. All underground for electrical, mechanical, and plumbing is installed that runs under the concrete building pad. The concrete pads for the Concession building, Home Building and grounds building were installed and the first course of block is installed. At the grounds building 3 lifts of block has been completed and door frames have been set. The Home stadium bleachers footings are installed and rebar has been set. The dugout steel for the field has been installed.

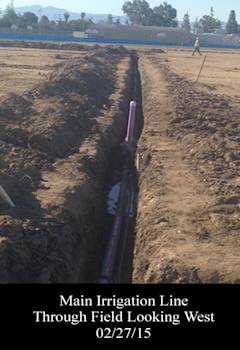

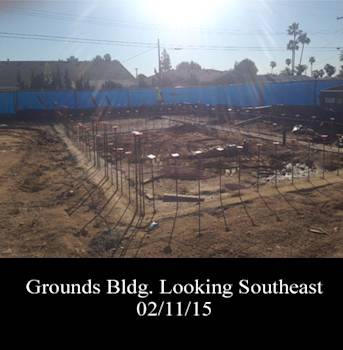

General: The new pool is currently tracking ahead of original schedule. The buildings are progressing well and the sitework is progressing. The main irrigation lines are being installed currently and the other site utilities are still progressing. The push over the next month is to complete concrete building pads and start forming building walls.
Phase 1 Quad: Started forming the stage area in preparation to pour concrete.

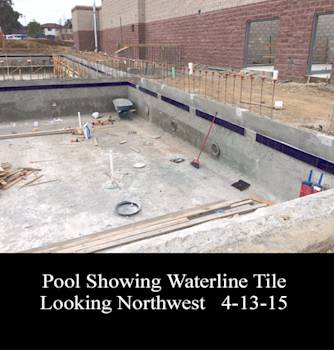

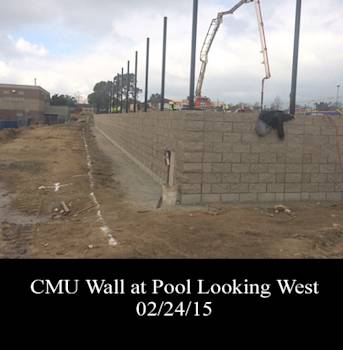

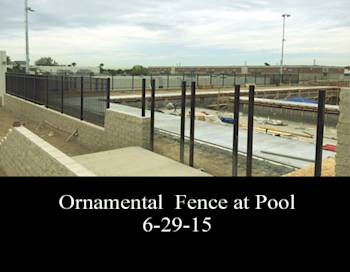

New Pool: The pool bottom is poured and all rough electrical and plumbing has been installed. The pool walls were formed. The CMU walls around the pool enclosure are complete with the vertical post for the ornamental fence.

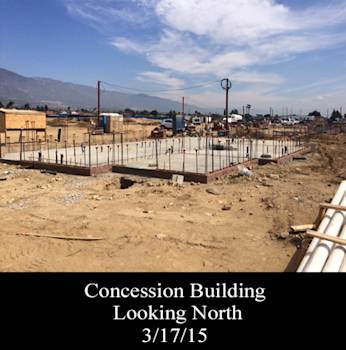

Stadium/Site: Site electrical, plumbing and main irrigation lines are progressing. The footings for the retaining wall at the practice and varsity softball fields are complete. The footings and the 1st course of CMU are installed for the visitor, home and concession buildings. The pit wall for the pool equipment building is poured and waterproofed. The ground building footings are poured and underground plumbing rough in is installed.
This Project was separated into multiple sections (Quad Area Phase 1, Quad Area Phase 2, New Pool Area, Stadium/Site/New Fields, and the Existing Varsity Baseball Fields)based on the job baseline schedule.

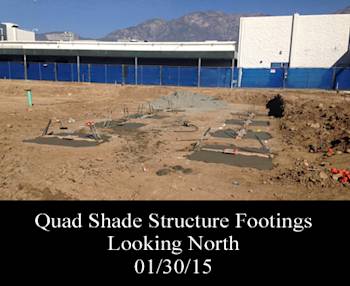

General: The progress for the new pool is on schedule well and the first health inspection was a success. The overall job is opening up for more trades now that the building pads are certified and the precise grading has been completed. Some of the major utilities have been installed and the shade structure footings for the 1st phase of the quad were completed.
Phase 1 Quad: Completed all demolition, rough graded area, install irrigation lines, storm drain and electrical. All footings for the shade structures was installed.

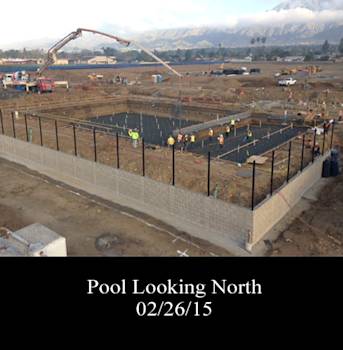

New Pool: The pool is shaped and rebar for the pool bottom and side is being installed. The health inspector for the pool visited the site and signed off all pipe and pool bottoms.

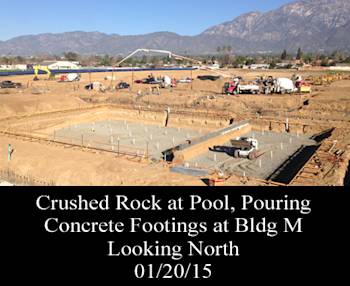

Stadium/Site: The site is completely fine graded. The main sewer line has been installed. Footings for the walls ( 450Lf ) surrounding the pool have been completed, the footings for Bldg. M (Visitor bldg.) is completed, the grounds bldg. pad was certified, main plumbing to bldg. and M is completed.
This Project was separated into multiple sections: Quad Area Phase 1, Quad Area Phase 2, New Pool Area, Stadium/Site/New Fields, and the Existing Varsity Baseball Fields.

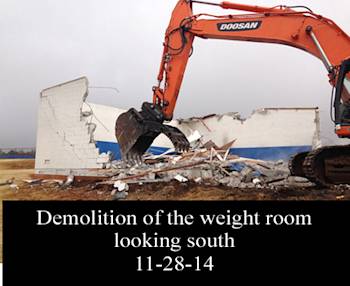

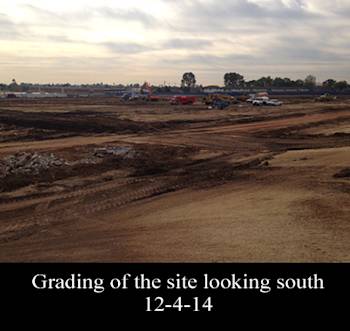

General: Tilden-Coil Constructors mobilized in November and setup all trailers and temporary power for the site. All utility lines safe-off was complete, temporary fence was installed and SWPPP measurements were all in place. During the month of December Tilden-Coil Constructors performed grading with main utility installation at roadway completed.

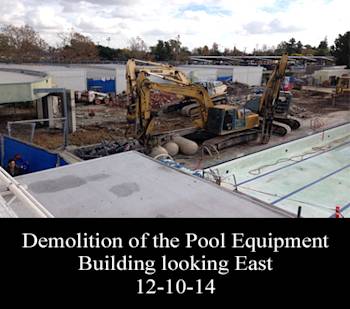

Phase 1 Quad: Demolition of all flatwork, pool equipment building, and existing pools is completed. The backfill and rough grade of the existing pools is complete and the storm drain has been completely installed.
Phase 2 Quad: Work is scheduled to start after school is out.

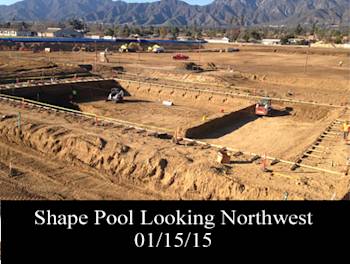

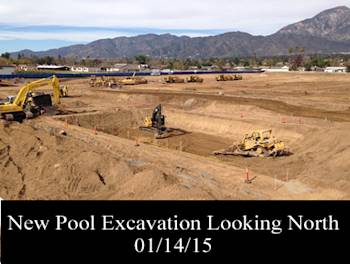

New Pool: The survey and mass excavation of the pool has started and is in progress. Rain events have delayed the job in progress.
Existing Varsity Field: The temp water line was installed and completed so that existing water line could be removed and demo during excavation.

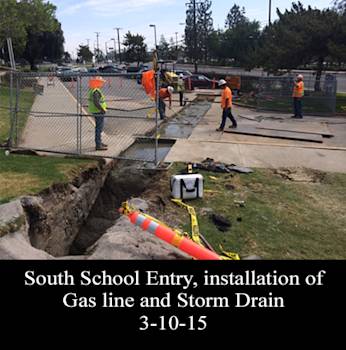

Stadium/Site: Started the rough grade of the site and exported over 18,000cy of dirt to the 7th street site. The main electrical line and part of the main gas line was installed at the west parking lot. The grading was delayed due to rain.
