Basement: Drywall patching is complete. Fire Alarm is complete. New AV equipment is ongoing. Door installation is ongoing.

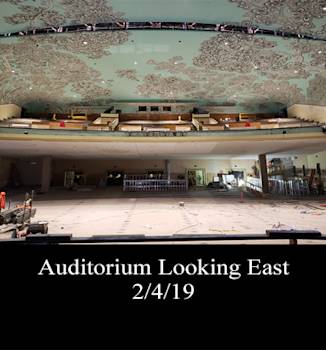

1st Level: Terrazzo polish is ongoing. ADA Ramp Ardex is complete. AV & electrical at booth are ongoing. Auditorium seating is complete. Carpet and path of travel lighting is ongoing. Door installation & refurbishment is ongoing. Concrete step restoration is ongoing.
2nd Level: Plaster patching is complete. Lobby Terrazzo polish is complete. Historical lights are installed. Dressing room vanity lights are complete. Architectural painting is complete at Balcony and main stairwells. Door installation is ongoing.

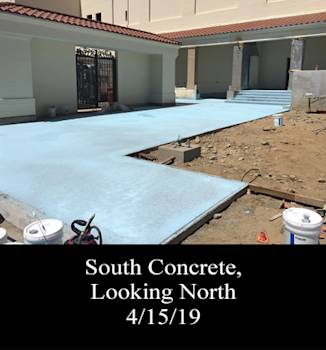

3rd Level: Dressing room plumbing finishes and vanity lights are complete. Stage theatrical lighting is ongoing.
Ceiling: Theatrical lighting is ongoing.
Roof: Complete

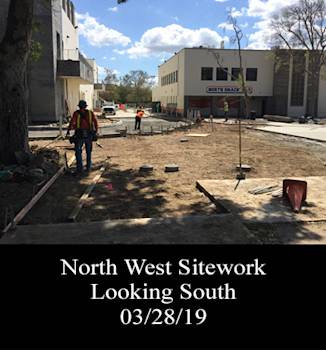

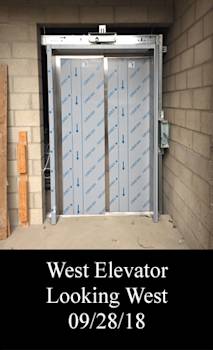

Sitework: North hardscape is ongoing. East hardscape is complete. Irrigation is ongoing, 14 of 18 olive trees are planted. Exterior painting is ongoing. Concrete restoration is complete. Site railings are ongoing.
Basement: Fire Alarm is on-going. New AV equipment is ongoing. Door installation is ongoing.
1st Level: Terrazzo is ongoing. Interior ADA Ramp concrete is complete. ADA Ramp transition work is in progress. Artist painting in Auditorium painting is complete. Sound control booth painting is complete. AV & electrical at booth are ongoing. Classroom flooring is complete. Auditorium seating is ongoing. Door installation is ongoing.
2nd Level: Plaster patching is ongoing. Lobby restoration and painting is ongoing. Dressing room flooring is complete. Architectural painting is ongoing at Balcony and main stairwells. Door installation is ongoing.
3rd Level: Dressing room plumbing finishes are ongoing. Plaster patching is complete. Stage theatrical lighting is ongoing. Classroom floorings are complete.
Auditorium: Theatrical lighting is ongoing. Stage rigging is complete.
Roof: Complete

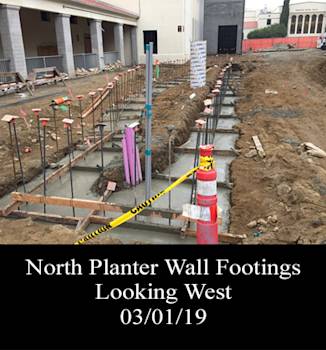

Sitework: North site/planter wall footings are complete & walls are poured. Waterproofing & backfill is complete. North ramp walls are poured. East concrete stairs & light pedestals are complete. Site light pole bases are complete. Concrete restoration is ongoing.
Basement: Drywall patching is ongoing. Lighting is complete. New HVAC for data room is complete. Painting is complete. New AV equipment is ongoing.
1st Level: Terrazzo is ongoing. Interior ADA Ramp concrete is ongoing. Interior ADA ramp wall framing is complete. Scaffolding removal is complete. Stage rigging is ongoing. Artist painting in Auditorium painting is ongoing. Sound control booth drywall is complete. AV & electrical at booth is ongoing. Classroom flooring is ongoing. Speakers are installed.
2nd Level: Plaster patching is ongoing. Lobby restoration and painting is ongoing. Terrazzo is complete. Dressing room flooring is ongoing.
3rd Level: Dressing room plumbing is ongoing. Plaster patching is ongoing. Stage electrical is ongoing. Classroom flooring demolition is complete.
Ceiling: Catwalk lighting is ongoing.
Roof: New smoke vents are installed. All roof patching is complete.

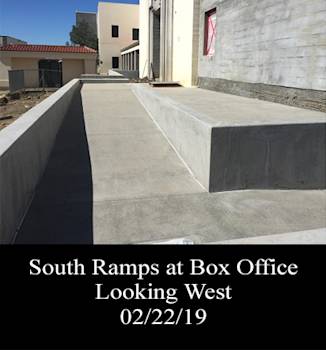

Sitework: South concrete ramps are complete. Storm drain tie-ins are complete. South and West Fire lane is complete. North grading is complete. North site/planter wall footings are ongoing. East concrete stairs is ongoing.
Basement: Plaster patching is complete. Drywall patching is ongoing. Toilet fixtures & accessories are complete. Lighting is ongoing. New HVAC for data room is ongoing. Painting is ongoing.

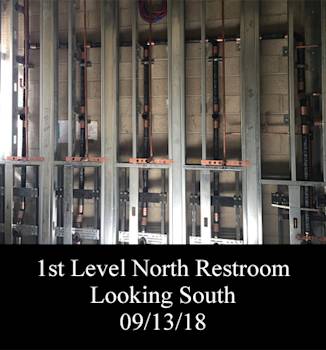

1st Level: North restroom partitions & accessories are complete. South restroom drywall is complete, MEP rough-in is complete. Interior ADA Ramp lower structural steel, decking and concrete are complete. Interior ADA ramp wall framing is ongoing. Scaffolding removal in the auditorium is ongoing. Stage rigging is ongoing. Sound control booth framing is complete. AV & electrical at booth is in progress.

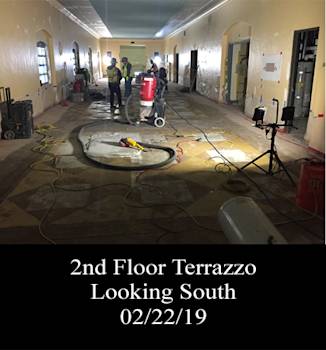

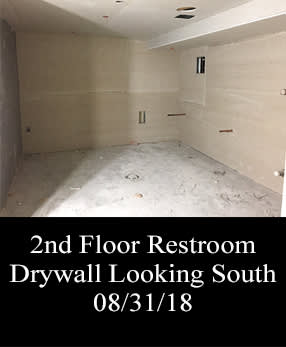

2nd Level: Balcony scaffold is removed. Restroom partitions & accessories are complete. Plaster patching is ongoing. Lobby restoration and painting is ongoing. Terrazzo lay has started.
3rd Level: Dressing room plumbing is ongoing. Plaster patching is ongoing. Stage rigging is ongoing. Auditorium Ceiling Mural painting is complete. Catwalk lighting is ongoing.
Roof: Existing smoke vents are removed. New smoke vent framing is ongoing.
Sitework: South planter walls are complete. Backfill at ramps is complete. Storm drain tie-ins are complete.
Basement: Fire Sprinklers are complete. Plaster patching is ongoing. Porcelain tile is complete at both restrooms. Plumbing finishes are complete.

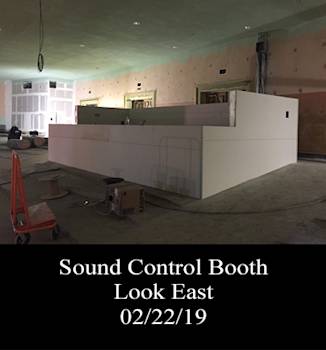

1st Level: Fire Sprinklers are complete at stage area. Electrical rough-in is complete. Lobby ceiling is complete. Plaster at underside of Balcony is complete. Sound control booth framing is complete. North restroom plumbing finishes are complete. South restroom framing is complete, MEP rough-in is ongoing in restrooms. Dressing rooms MEP rough-in is complete and drywall is complete. Excavation & concrete slab are complete at ADA ramp. Steel embeds for ADA ramp are complete.

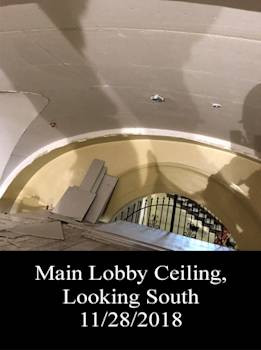

2nd Level: Lobby ceiling is complete. Electrical rough-in at lobby is complete. Interior handrails are complete. Plumbing finishes are installed at restrooms.
3rd Level: Dressing room plumbing is ongoing. Stage rigging is ongoing.

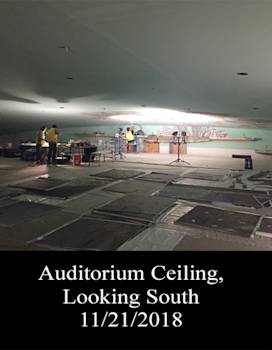

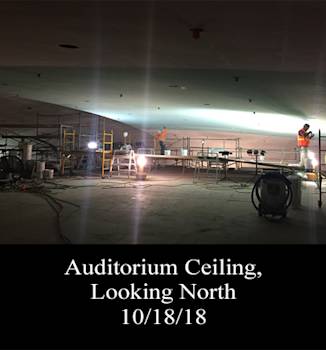

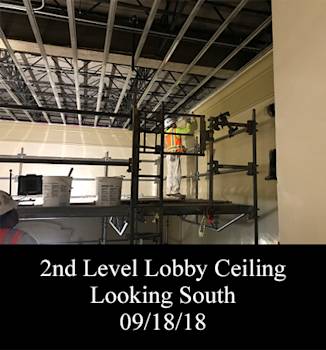

Ceiling: Auditorium drywall and BASWA panels are complete. Finish coat has started at the East half. Joints are taped at the West half. Mural painting is ongoing. Audio Visual conduit is complete. Fire sprinkler finish is ongoing.
Auditorium Ceiling: BASWA finish coat is complete. Mural painting is ongoing.

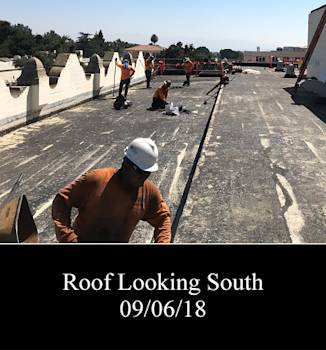

Roof: Main roofing is complete. New HVAC curbs are complete. Clay tile at Arcades are complete.

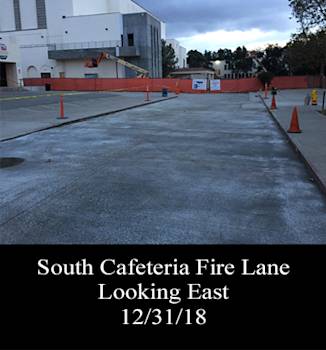

Sitework: South grading is complete. West grading is ongoing. Plaza seat walls are complete. South planter wall footings are complete. Storm drain tie-ins are ongoing. Fire lane south of cafeteria is complete.
Basement: Fire Sprinklers are progressing. Drywall/Taping is complete. Plaster patching is ongoing. Floor and wall porcelain tile is complete at one of two restrooms.
1st Level: Fire Sprinklers are ongoing at stage area. Electrical rough-in at lobby is ongoing. Plaster at underside of Balcony is ongoing. Existing sound control booth removal is complete. North restroom drywall and tile is complete. South restroom floor is poured, Mechanical, Electrical, Plumbing rough-in is ongoing. Dressing rooms are framed and Mechanical, Electrical, Plumbing rough-in is ongoing. East elevator is installed. Demolition for ADA ramp is complete. Excavation & concrete slab are ongoing.
2nd Level: Restroom tile at the floor and walls are complete. Electrical rough-in at lobby is ongoing. Acoustical ceiling is in progress. Stair security gates are installed except for gate hardware. Interior handrails are complete.
3rd Level: Mechanical piping/ductwork is complete. Audio Visual rough-in is complete at dressing rooms. Projection booth windows are cut. Stage rigging is ongoing.
Ceiling: Auditorium drywall and BASWA panels are complete. Finish coat has started at the East half. Joints are taped at the West half. Mural painting is ongoing. Audio Visual conduit is complete. Fire sprinkler finish is ongoing
Roof: Main roofing is complete. New HVAC curbs are ongoing. Clay tile at Arcades is ongoing.
Sitework: South demolition is complete. South grading is ongoing.
Basement: Fire Sprinklers are ongoing. Drywall/Taping is complete. Plaster patching is ongoing. Tile is complete at one of two restrooms.
1st Level: Fire Sprinklers are ongoing at stage. Electrical rough-in at lobby is ongoing. Plaster at underside of Balcony is ongoing. Existing sound control booth is complete. North restroom drywall and tile is complete. South restroom concrete deck is poured, mechanical, electrical and plumbing rough-in is ongoing. Dressing rooms are framed and mechanical, electrical and plumbing rough-in is ongoing. East elevator is installed.
2nd Level: Restroom tile is complete. Electrical rough-in at lobby is ongoing. Stair security gates are installed except for gate hardware. Interior handrails are complete.
3rd Level: Mechanical piping/ductwork is complete. Audio visual rough-in is complete at dressing rooms. Projection booth windows are cut. Stage rigging is ongoing.
Ceiling: Auditorium drywall and acoustical panel installation is complete. Finish coat has started at the East half. Joints are taped at the West half. Audio visual conduit is complete. Concrete crack repairs are complete.
Roof: Main roofing is complete. New mechanical curbs are ongoing. Clay tile at Arcades is ongoing.
Sitework: South demolition is complete. South grading is ongoing
In the basement, drywall/taping is ongoing. Plaster patching is ongoing. On the 1st Level, the lobby & stage restroom expansion interior framing/drywall is ongoing. Fire sprinklers are ongoing at the stage. Electrical rough-in for historical lights is ongoing. Lights at the underside of the balcony are complete. The lath and plaster at the balcony has started. The East elevator is complete, less cab finishes and call lanterns. The West elevator install has started. On the 2nd Level, HVAC piping/ductwork is complete. The electrical rough-in is complete. The restroom tile has started. On the 3rd Level, HVAC piping/ductwork is complete. The walkway demolition is complete. The auditorium ceiling framing is complete at the East half, the lights are installed and programmed. The drywall is complete at the West half and started at the East half and side walls. The acoustical panels are ongoing – a radius and side walls. The audio visual rough in for conduit is complete. The PVC roofing is complete with the commencement of the demolition of the clay tile roofs at the arcades. The site work utility tie ins are ongoing.
The soffit framing for the north elevated walkway is complete. The soffit plaster finish coat at the north walkway is complete. The west elevator tower plaster is complete The basement demolition is complete. The basement framing is ongoing. The 1st floor lobby & stage restroom expansion interior framing is ongoing. The drywall at the 2nd floor restrooms is ongoing. The fire sprinklers are complete at the 2nd level restrooms and are ongoing at the 2nd level lobby. The 2nd & 3rd level HVAC piping is ongoing. The electrical rough-in is ongoing at all levels. The catwalk installation is complete. The new roof access ladders are complete. The ceiling framing at the 1st level lobby is complete. The framing at the underside of the balcony is complete. The auditorium ceiling framing is complete at the east half, the lights are installed and the drywall has started. The auditorium ceiling framing at the west half is ongoing. Auditorium Fire Sprinklers are complete. A/V conduit is ongoing throughout building. Roofing demolition is ongoing and re-roofing has started. Site Fire Water & Sewer Utilities project is complete.
The plaster finish coat is complete at the stair tower. The soffit framing for the north elevated walkway is complete. The soffit plaster finish coat at the south walkway is complete. The West elevator tower plaster is ongoing. The basement demolition has started. The 1st floor restroom expansion exterior finish plaster is complete. The 1st floor restroom expansion interior framing has started. The wall framing & mechanical, electrical and plumbing rough-in are complete at the 2nd floor restrooms. The fire sprinklers are ongoing at the 2nd level restrooms. The 2nd & 3rd level HVAC piping is ongoing. The electrical rough-in is ongoing at all levels. The ceiling framing at the 1st level lobby is ongoing. The fire sprinklers at the 1st level balcony is complete. The framing at the underside of the balcony is ongoing. The fire sprinklers in the classrooms are complete. The catwalk framing is ongoing. The auditorium lighting rough-in is ongoing. The auditorium fire sprinklers are ongoing. The auditorium ceiling framing is ongoing. The roofing has started this month.

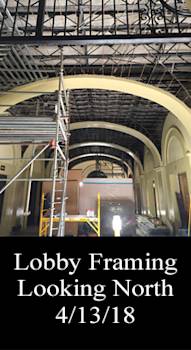

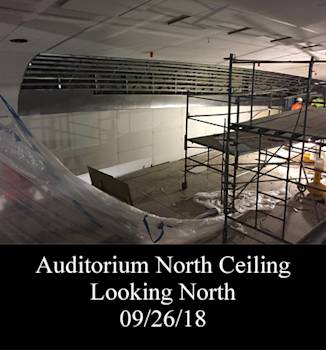

The West elevator tower CMU is ongoing. The soffit framing for the elevated walkway is complete. The soffit lath is complete at the south walkway and ready for plaster. The auditorium ceiling framing has commenced and the fire protection at the auditorium ceiling is in progress. The steel girder supports at the auditorium ceiling are complete. The new catwalks are in progress. The 2nd floor restroom framing is in progress. The wall framing & MEP rough-in is ongoing at the 1st & 2nd floor restrooms. The plumbing rough-in is ongoing at all levels. The electrical rough-in is ongoing at all levels. The ceiling framing at the 1st level lobby is ongoing. The 3rd floor classroom ADA ramps are poured out along with the elevated walkway. The new fire, water, and sewer lines to the street are installed. The street tie in is to be completed after summer school it out.
The lath is complete at the stair tower and ready for plaster. The west elevator tower back fill is complete. The west elevator tower CMU is ongoing. The soffit framing for the elevated walkway is complete. The soffit lath is complete at the south walkway and is ready for plaster. The 1st floor restroom expansion framing is complete and the lath is complete and ready for plaster. The elevated deck slab at the 2nd floor restrooms is ongoing. The wall framing & MEP rough-in is ongoing at the 1st & 2nd floor restrooms. The basement & 1st level HVAC piping is complete. The plumbing rough-in is ongoing at all levels. The electrical rough-in is ongoing at all levels. The ceiling framing at the 1st level lobby is ongoing. The scaffold installation at the underside of balcony for framing is complete. The 3rd floor classroom ADA ramps are framed & decked ready for new concrete. The girders for catwalks are complete.

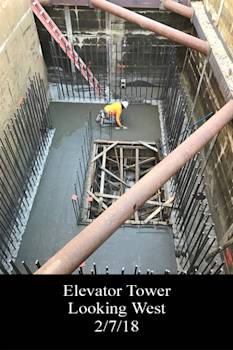

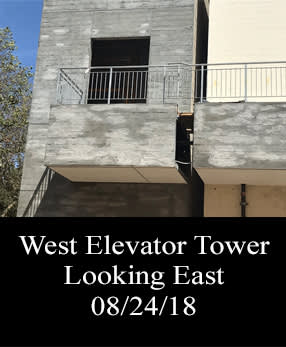

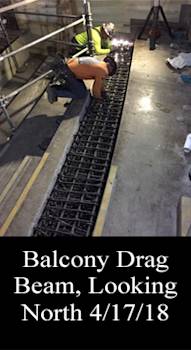

The steel stairs & railings are complete at the stair tower. The plaster at stair tower has started. The west elevator tower mid-level slab is complete and CMU is ongoing. The west elevator tower backfill is ongoing. The east (interior) elevator tower CMU is complete and 2nd level slab is poured. The exterior elevated walkway steel & guardrail connecting stair tower and west elevator is complete. The soffit framing for elevated walkway has started. The exterior frame, rebar & formwork and concrete are complete. The concrete slabs are poured at the basement restrooms and the 1st level restroom extensions. The wall framing & mechanical/electrical/plumbing rough-ins are ongoing at the 1st & 2nd floor restrooms. The basement & 1st level HVAC piping is ongoing. Plumbing rough-in is ongoing at all levels. The electrical rough-in is ongoing at all levels. The ceiling framing at 1st level lobby has started. The scaffold installation at underside of balcony for framing has started. The exterior HVAC piping is ongoing.

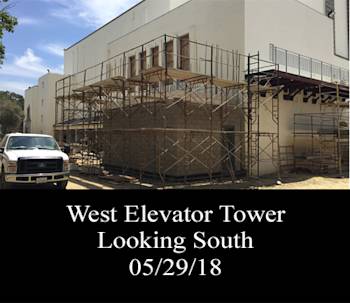

New stair tower masonry is complete up to the roof. The new steel stairs are being installed in the tower. The new west elevator tower is ongoing. The new east (interior) elevator tower CMU is progressing. Exterior elevated walkway steel connecting stair tower and west elevator has started this month. Exterior moment frame demolition is complete at the sides of the auditorium. Exterior moment frame concrete formwork has started and is ongoing. Footings are poured at basement restrooms. Wall framing & MEP rough-in is ongoing at 1st & 2nd floor restrooms. Basement HVAC piping is ongoing. The basement restroom modification work is underway with demolition and layout complete.

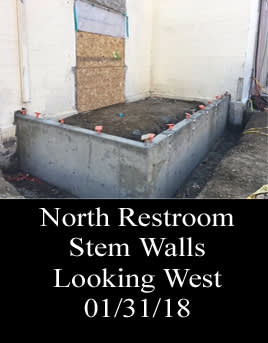

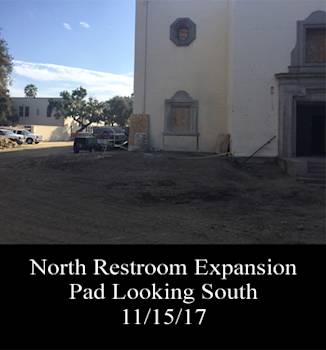

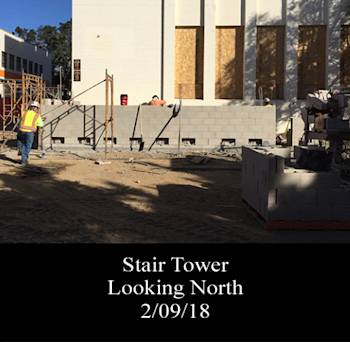

Restroom expansion footings are complete at the north and south. West elevator CMU walls are ongoing. Stair tower CMU is ongoing. Electrician is onsite for rough-in as CMU is built.

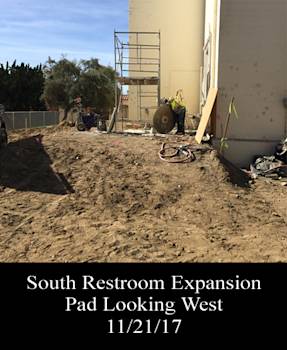

Interior work is scheduled to commence upon completion of the abatement procedures. Restroom expansion footings are complete at the north and in progress at the south. Stair tower grade beams are complete and starter walls are finished. West elevator starter walls are complete. Starter walls and slab on grades at stair and elevator towers are complete. Electrician is onsite for rough-in as CMU is built.

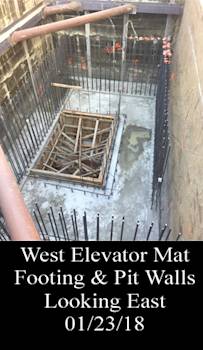

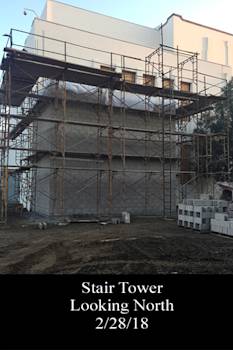

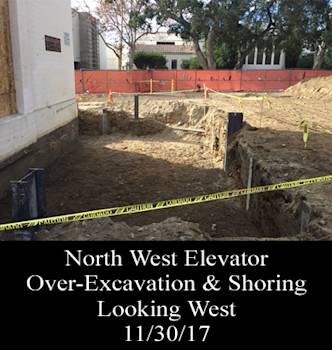

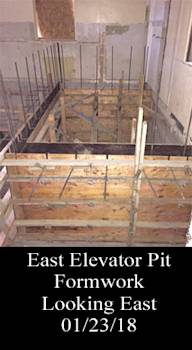

Excavation and shoring for west elevator is complete. Restroom expansion footings are in progress. Stair tower caissons are complete and grade beams are in progress. Shear wall caissons are complete & pile caps poured. Abatement continues on the interior and has given access for the structural steel contractor to weld new supports at the Balcony. South ADA ramp walls are complete.

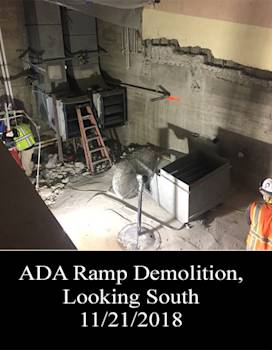

Change order demolition of plumbing & electrical rough-in is complete. Interior concrete demolition for ADA seating is complete. Additionally the north Arcade over-excavation is complete along with the over-excavation at restroom expansions is complete. The over-excavation at east elevator is ongoing. Shoring for north west elevator has started again with the revised pile layout. Shear wall caisson footings has started. Plumbing at basement is ongoing.

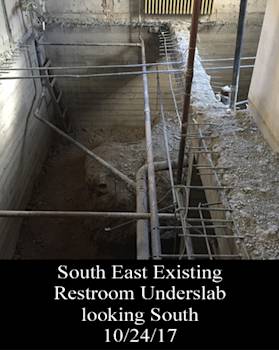

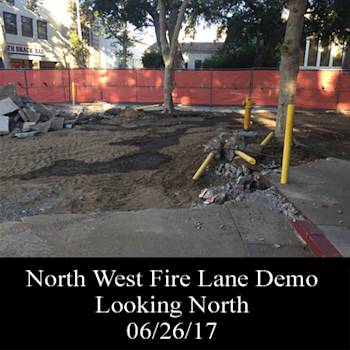

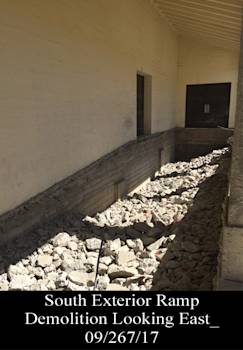

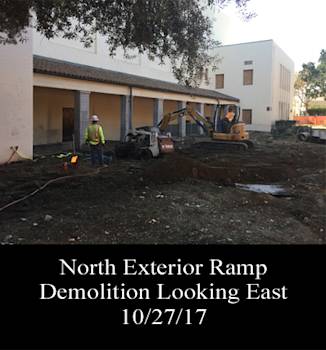

Demolition of plumbing & electrical rough-in is ongoing. Minor misc. interior abatement is finishing up. Interior concrete demolition for ADA seating has commenced this month. Initial exterior sitework demolition is complete. South Arcade over-excavation and recompaction is complete. North Arcade over-excavation and recompaction is on-going. Shoring for North West elevator is on hold pending the Edison line reconfiguration required to miss the line. Plumbing contractor is onsite laying out new piping and materials have been delivered.

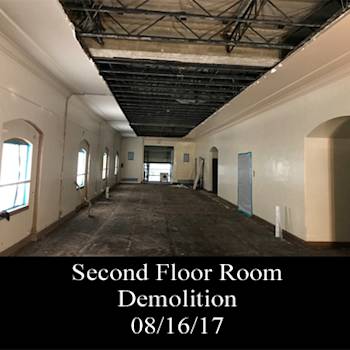

Interior demolition is continuing, the basement level is complete and the auditorium ceiling was completed this month. Work is progressing on the interior, with work on removing the lobby ceiling and abatement is staying ahead of the demolition. The exterior demolition closer to the building has commenced with walkways and ramps. Shoring at the northwest corner for the new elevator is ongoing.

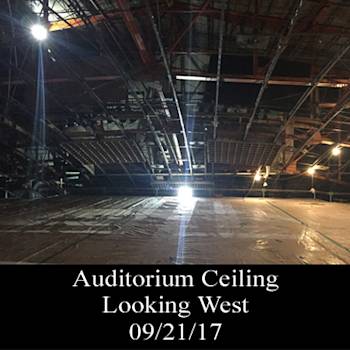

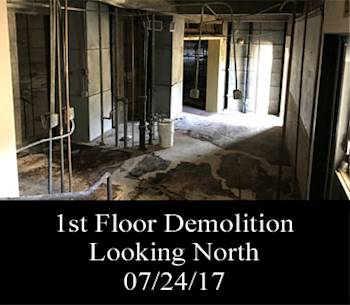

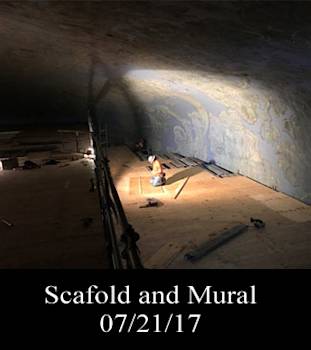

Exterior demolition is complete until exterior flat work starts back up next spring. Interior demolition and abatement is ongoing on numerous floors. Ceiling mural documentation is complete. Auditorium ceiling demolition has started.

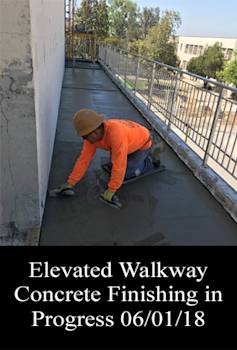

Exterior demolition is ongoing. Main exterior utility installations are complete, this includes the Edison relocation of an existing panel to accommodate new stair tower. Walkway patching is ongoing. Auditorium interior scaffolding is complete. Interior demolition and abatement is ongoing with the basement level completed this month. Ceiling mural verification and pictorial documentation is ongoing.
Exterior demolition has started along with underground utilities. Interior demolition and abatement has also commenced and the auditorium seating removal is complete. The interior scaffolding is progressing in auditorium.
