Current status of project. Pool commissioning is in progress with the final audio adjustments. Training and punchlist finalization are scheduled for next month.

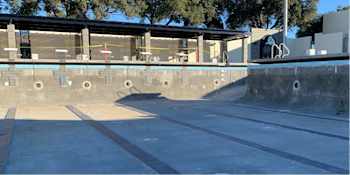

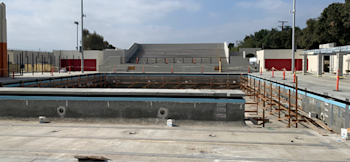

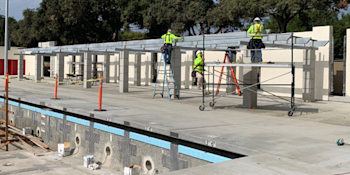

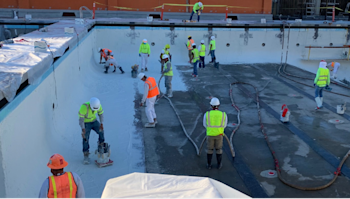

Current status of project. Pool preparation for plaster, equipment room wiring completion, fencing and gates, bleacher installation, remaining site concrete preparation, painting at exterior.

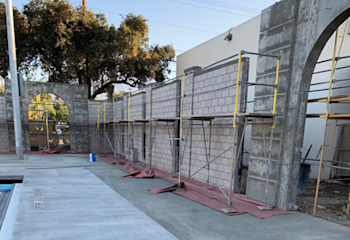

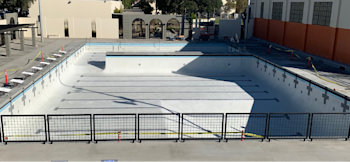

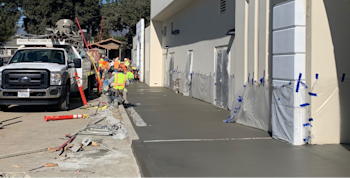

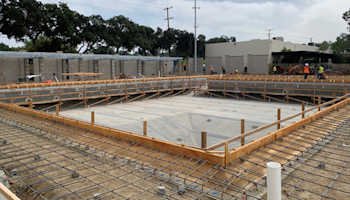

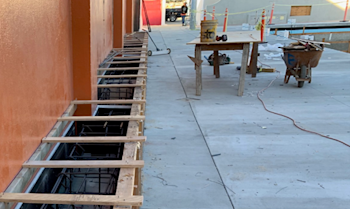

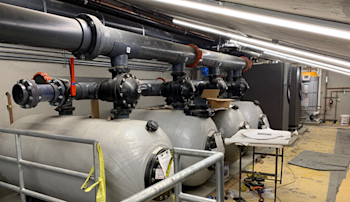

Current status of project. Pool deck concrete completed, pool equipment installed, final wiring to pool equipment, finishes at restrooms, plaster at site walls and restrooms.

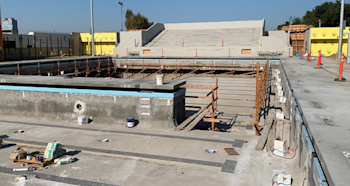

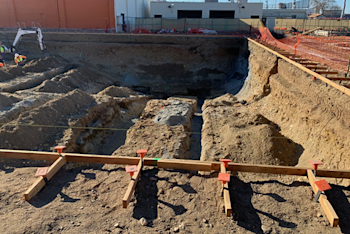

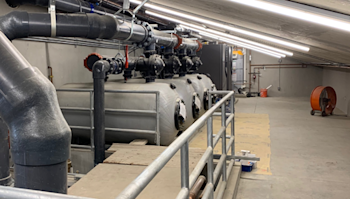

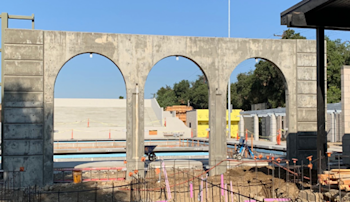

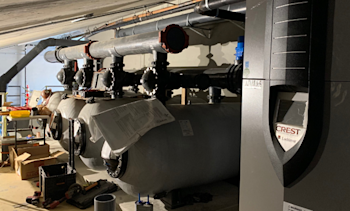

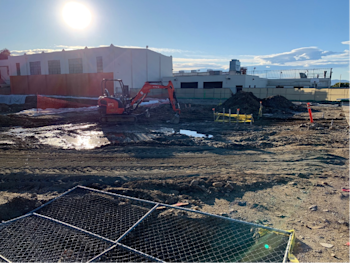

Current status of project. Pool equipment building infrastructure and equipment installed. Pool deck concrete pour. Tile at restroom complete. New Fire water service at 5th street completed.

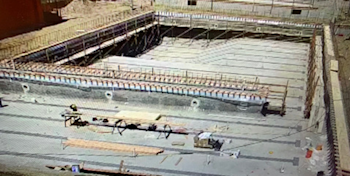

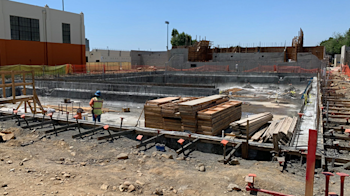

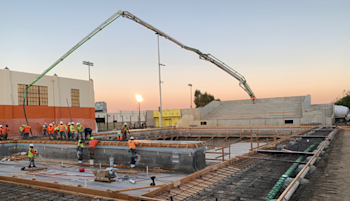

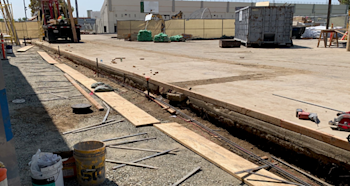

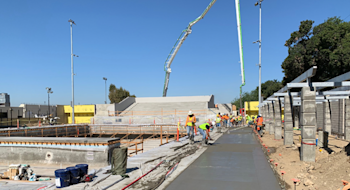

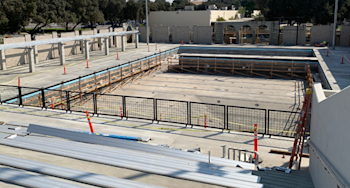

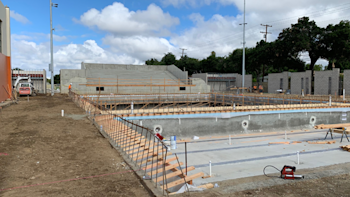

Current status of project. Pool area deck to slot drain poured, pool equipment installation started, concrete entries at site walls, fire water connection at 5th street.

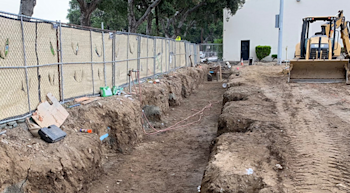

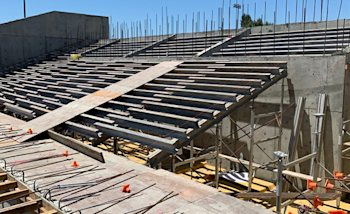

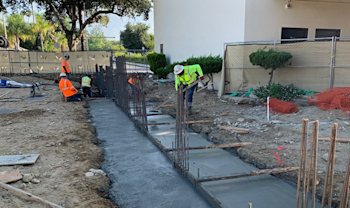

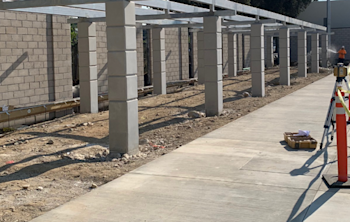

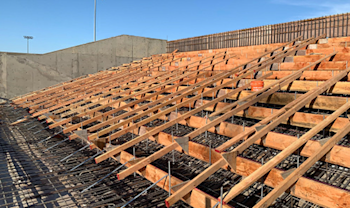

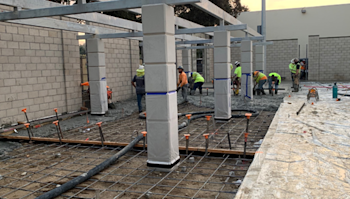

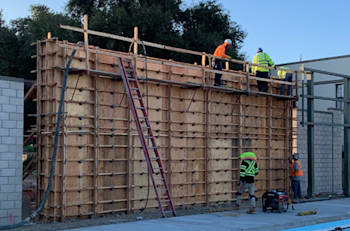

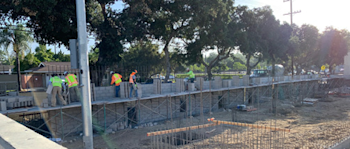

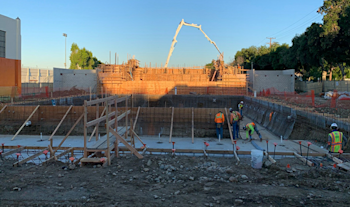

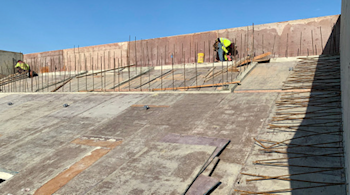

Current status of project. Pool building elevated deck and risers poured, pool gutter installed, pool tile installed. North and east site CMU walls built.

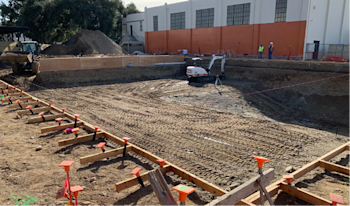

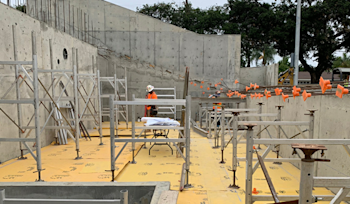

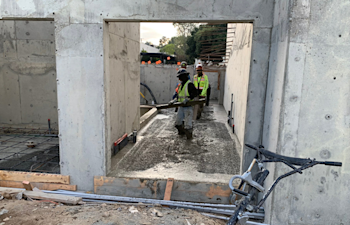

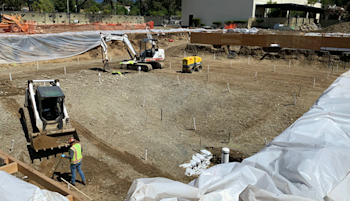

Current status of project. Pool building slab on grade poured, forming of elevated deck at pool building started, electrical and plumbing rough at all buildings in conjunction with walls. Pool stairs, gutters and surge pit installed.

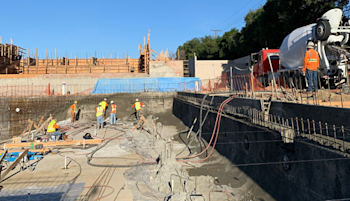

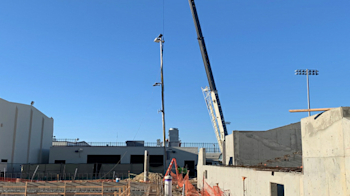

Current status of project is the Pool building walls are formed, rebar is installed and walls poured in place. The electrical and plumbing rough in at all buildings is in progress in conjunction with walls. The pool utilities are installed. The pool rebar is installed at pool floor and the pool floor was poured this month. The pool rebar at the walls was installed with the shotcrete at the pool walls completed. The Musco light poles delivered to the site and the foundations were installed for the light poles. The new sewer through the North Quad was completed. Quad fire water installed to city property, pending approval for a time to make the connection from the City. The patchback of the hardscape at the quad was completed.

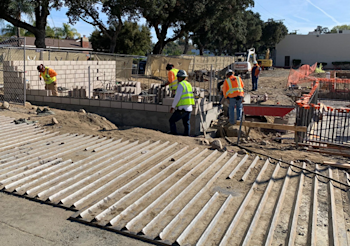

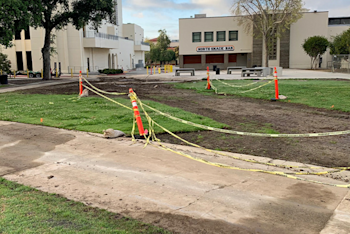

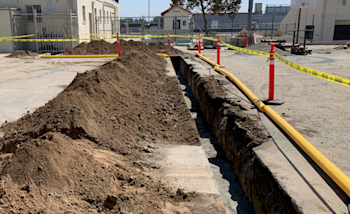

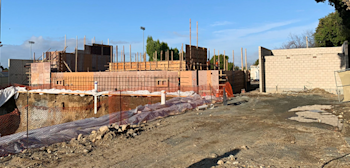

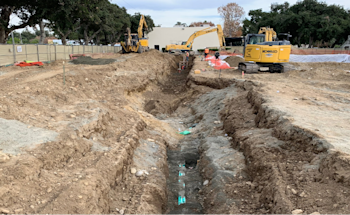

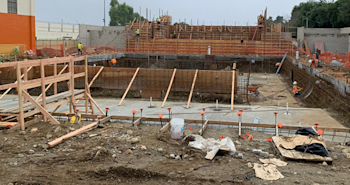

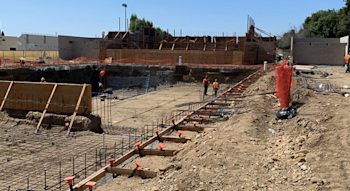

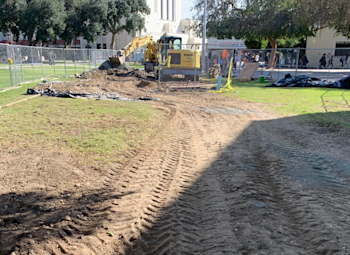

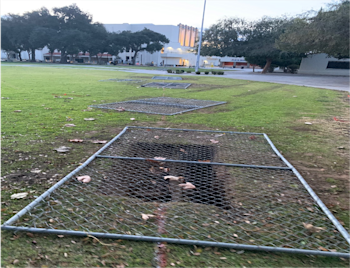

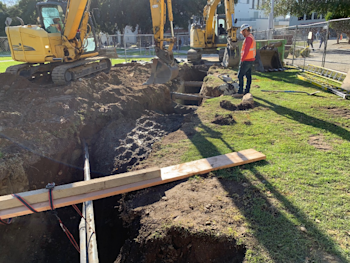

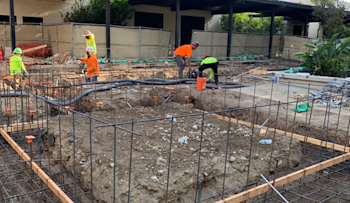

Current status of project is walls at boys and girls restroom are in progress. The layout is complete and forming of the walls for the pool building with bleachers has commenced this month. Electrical and plumbing rough at all buildings is progressing. Shaping of the pool is complete and the trenching for the pool underground utilities has also started this month. The fire water at north quad is progressless at the tie in at the City street, as that is on hold by order of the City of Ontario. At the north quad, the sewer line is installed from pool equipment building through quad to lower manhole at GWS building which connects both sides of the campus. Currently investigating water connections and sewer for final sewer connection.

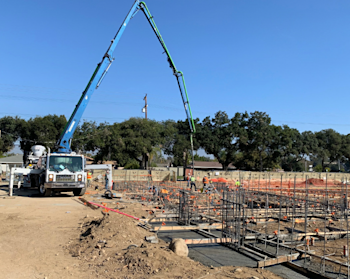

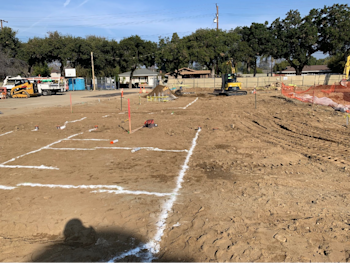

Current status of project is the footing excavation and concrete pour for the pool and two restroom buildings. In wall and slab electrical and plumbing at buildings. Pool edge layout and shaping of the pool soil for final layout. At North quad sewer line is installed from pool equipment building through quad to lower manhole at GWS. Currently investigating water connections and sewer for final sewer connection.

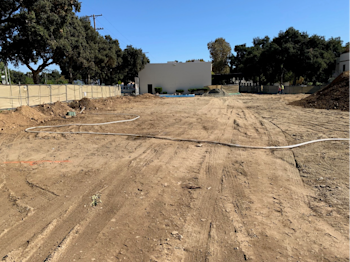

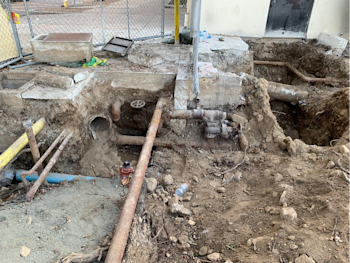

Current status of project is completing the demo and grading to prepare for the building pads and site underground utilities consisting of electrical, sewer, storm drain and pool piping. At north quad the sewer investigation is underway to verify path for new line being installed.

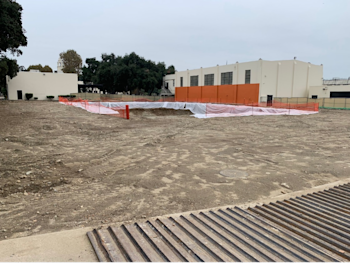

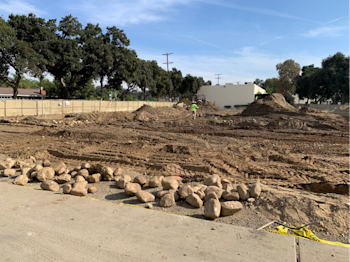

Current status of project is completing the demo and grading to prepare for the building pads for the restrooms, bleachers and pool equipment areas. Exploratory work for the site underground utilities consisting of electrical, sewer, storm drain and pool piping is in progress. At the North quad the sewer investigation is underway to verify path for new line being installed. The rain days and required dry out time limited the progress this month.

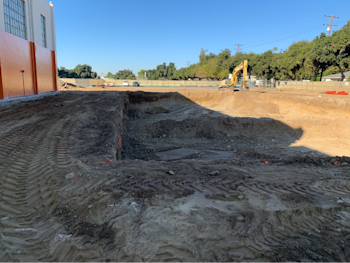

Project site mobilization, safe off of MEP, demo of existing tennis courts and creating site limits. Rough grade and over excavation of site and buildings with rough cut of the new pool.
