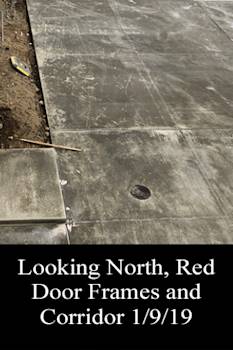

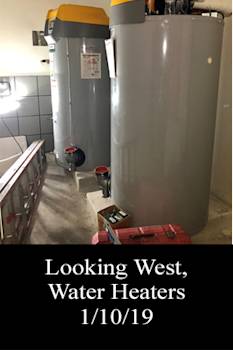

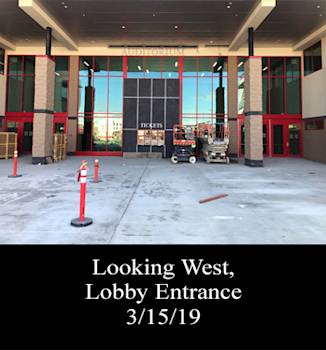

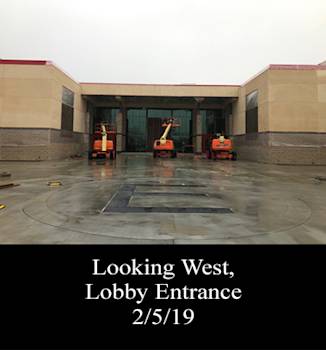

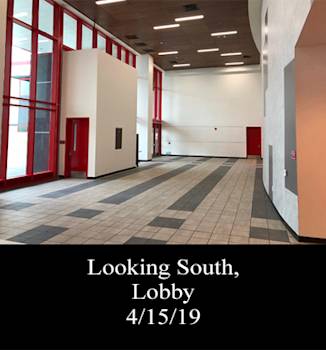

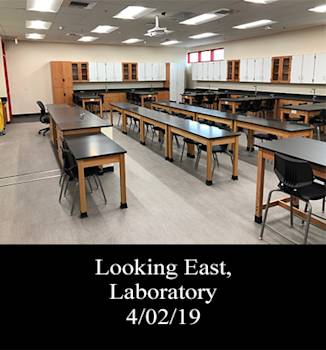

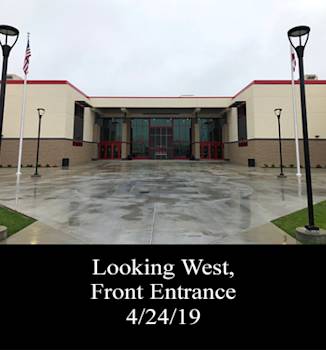

The construction management punchlist has been generated and the the trades are completing the items. Testing and air balance of the HVAC equipment in the building is complete. The plumbing system clorination is complete. The wheel chair lift is installed. The theater audio and lighting is installed and working. The fire alarm system has been inspected and signed off. The Building Dedication is 5/7/19.
Northernmost Area running North/South: Level 1 and 2, Flooring is complete and the initial punch list is in progress with the prime contractors.
Northernmost Area running East/West: Level 1 Architect punch list started and will work up to the 2nd floor upon completion of Level 1 in this area.

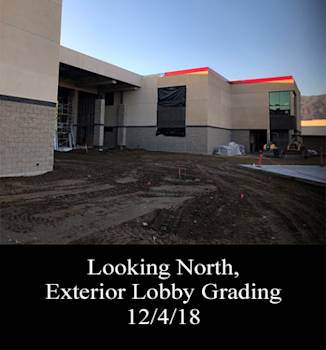

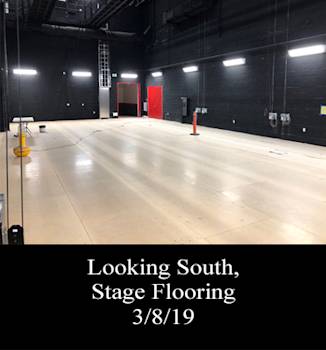

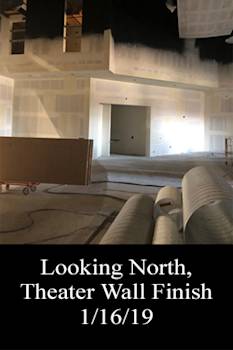

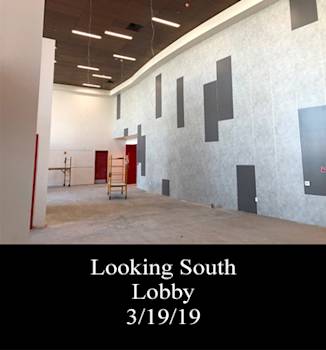

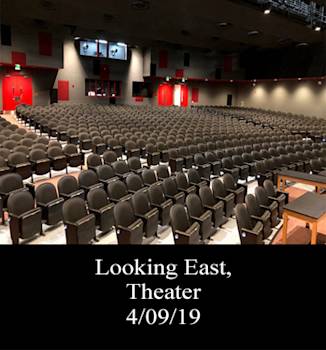

Auditorium Area: The seating is complete, the wood stage floor is complete, the stage face is in progress, the lobby ceiling tiles are complete and the lobby tile flooring is starting and the wire is being pulled into the sound booth.
Southernmost Area running East/West: Level 1 and 2 are ready for Architect punch list and will progress upon completion of the Northernmost Area running East/West.

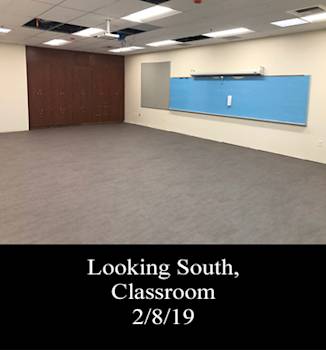

Southernmost Area running North/South: Level 1 flooring is in progress, the initial punch list is currently being generated. Level 2 flooring is complete and the initial punch list is in progress with the prime contractors.
Elevators were signed off by the state inspector on 3/18. The wheel chair lift is scheduled for installation next month. The overall project signage has started this month along with projectors.

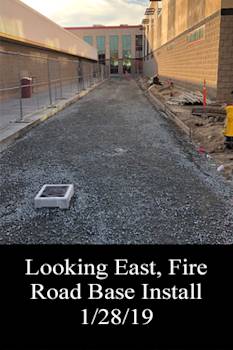

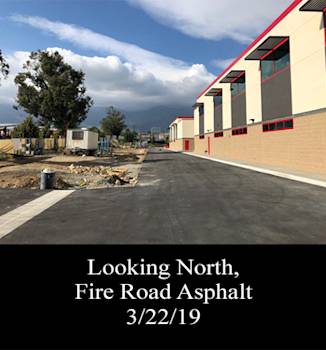

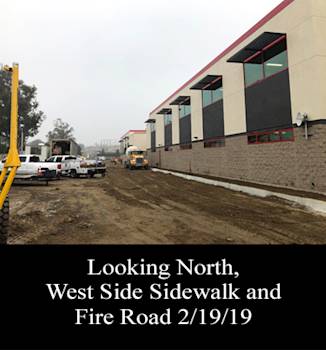

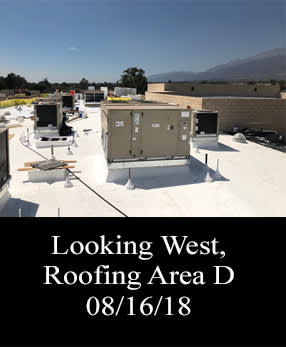

Site/Roof: The HVAC unit counter flashing was installed, the fire road asphalt is complete (except for the area where new future 12 classroom building footprint is located. All exterior concrete is complete, planter irrigation is currently being installed and the plants are scheduled to be installed next month. Fence panels are currently being installed and the exterior block and plaster painting is complete.
Northernmost Area running North/South: Level 1 final cabinets and trim are being installed. Level 2 ceiling tiles are installed, the lights are turned on, and the toilet accessories are installed.
Northernmost Area running East/West: Level 1 flooring is installed in this area. Level 2 Floor preparation is starting. All the wall accessories are complete and the ceiling tiles are all installed.

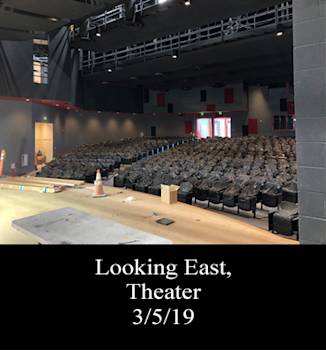

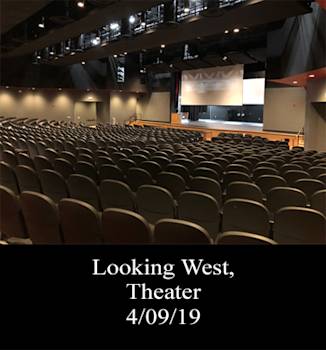

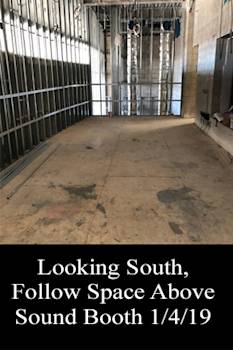

Auditorium Area: Acoustical wall panels are complete, the stage rigging is complete, the walls in the theater are painted, the stage is painted black, the roof smoke hatches are connected and complete, the sound booth window is currently being installed, the epoxy floor is complete, the seats are currently being installed, the lobby storefront is complete (except trim), the lobby ceiling grid is installed and Mechanical, Electrical and Plumbing trades are currently installing ceiling connections.
Southernmost Area running East/West: On Level 1 and 2 the flooring is complete on both levels in this area.
Southernmost Area running North/South: Level 1 Ceiling tiles are all installed. All the wall accessories are installed in the classrooms. Level 2 flooring is complete. The architect set up to walk this area.
Site/Roof: The South side concrete is poured. The West side curb along the road is poured, the light pole bases are excavated and underground conduit work is taking place. The South side fence posts are currently being installed. The exterior paint on the plaster is 50% complete. All the Air Handling Units except 3-4 are running on the roof for climatizing the building.
Northernmost Area running North/South: Level 1 T-bar tiles are being dropped. The electrical trim is complete. The markerboards, fire extinguisher cabinets and projection screens are installed. Level 2 ceiling grid is installed, the mechanical systems are to grid, the electrical trim is complete, and the doors are installed.
Northernmost Area running East/West: Level 1 Flooring is installed. Level 2 electrical trim is complete and the doors are installed with hardware. The tile in bathroom is complete and the plumbing finish has started.

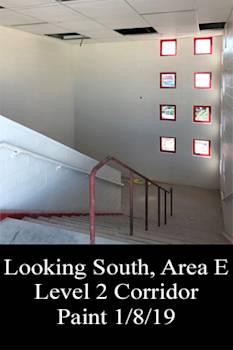

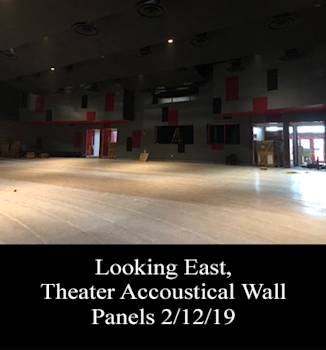

Auditorium Area: The auditorium ceiling scaffolding is removed, the low walls are painted, and the acoustical wall panels are being installed. The lobby walls are painted, the wall tile is installed, and the storefont is starting to be installed. The rigging contractor is in progress and the overhead coiling doors are installed.

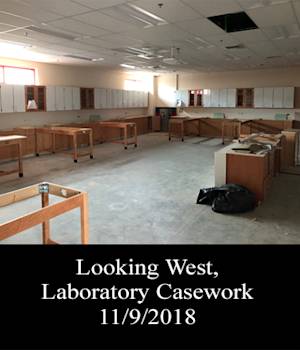

Southernmost Area running East/West: Level 1 floor prep has started and the casework is complete. Level 2 doors are installed, the hardware is installed, and the electrical trim is complete.
Southernmost Area running North/South: Level 1 corridor ceiling tiles are complete, the doors and hardware are installed, the electrical trim is complete, and the marker board, tack board, fire extinguisher cabinets and projection screens are installed. Level 2 electrical trim is complete, and the marker board, tack board and fire extinguisher cabinets are installed.
Site/Roof: The HVAC units are running, the east concrete sitework is poured in front of the lobby, and the concrete flatwork preparation is taking place on the south side.

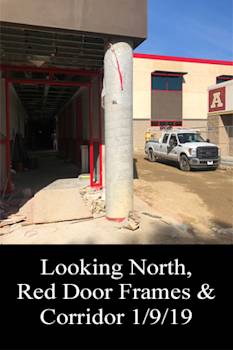

Northernmost Area running North/South: Level 1 doors and hardware are installed, ceiling tile is being installed. Porcelain Tile is installed in the restrooms. Level 2 prime and first coat of paint is complete and T-bar is starting.
Northernmost Area running East/West: Level 1 doors and hardware is installed, floor prep is starting and flooring to start first week in January. Level 2 restroom tiles are installed, overhead utilities are complete and ceiling tile is ready to be dropped.

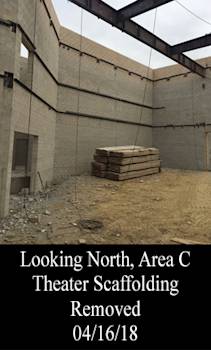

Auditorium Area: Paint is complete above the theater and dance floor. Scaffolding is scheduled to be removed first week of January. Lobby framing is complete and ticking booth is being plastered.

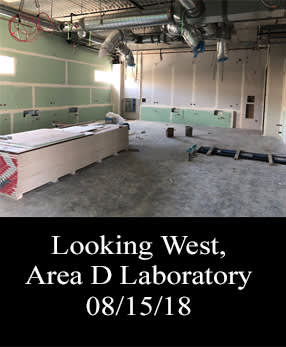

Southernmost Area running East/West: Level 1 doors and hardware are installed, laboratory casework is 90% complete. Restroom tile is complete, restroom plumbing and partitions are installed. Level 2 corridor ceiling utilities are complete and the ceiling tile is ready to be dropped.
Southernmost Area running North/South: Level 1 doors and hardware are installed and ceiling tile is installed. Restroom tile is complete.

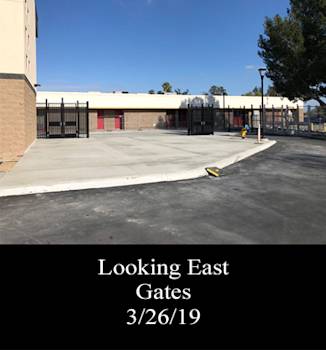

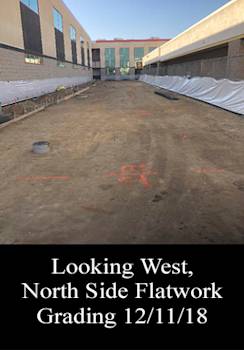

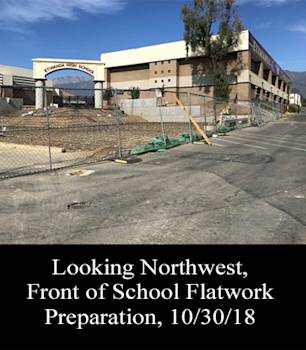

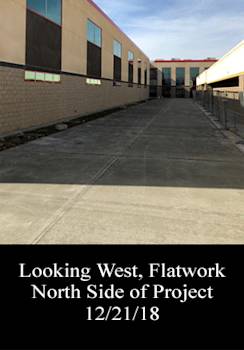

Site: Fine grading is complete on north, east and south side of the project. Light pole bases our poured, the acid neutralization tank is being installed and rebar has started along the north side of the project. Sun shades are installed. The remaining exterior door frames are installed.

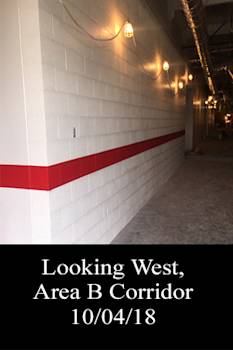

Northern Most Area: Level 1 prime and first coat are complete and the ceiling grid is installed. The utilities are being put and in and seismic wires and compression posts are being installed. Level 2 drywall is complete and mud/tape and sand is taking place.
East/West Northern Area: Level 1 casework is installed, the ceiling tiles are installed, and the marker board is installed. Level 2 prime and first coat are complete, the ceiling grid is installed, and the marker boards are installed. The utilities are being put in the grid and seismic wire and compression post are being installed.

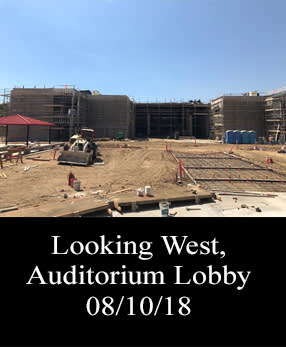

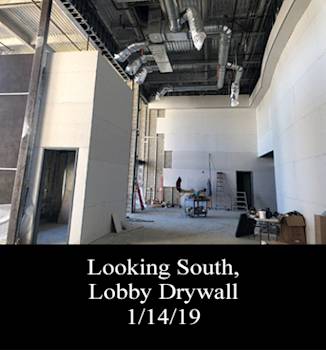

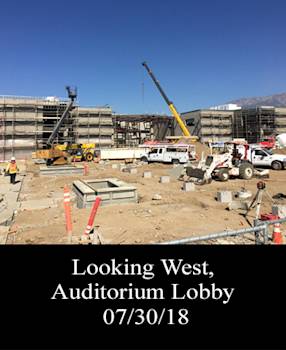

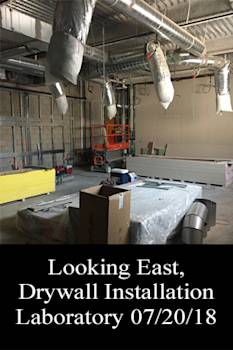

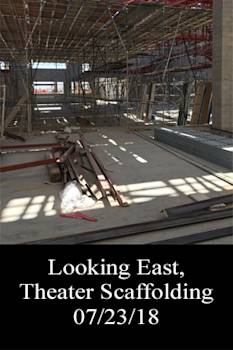

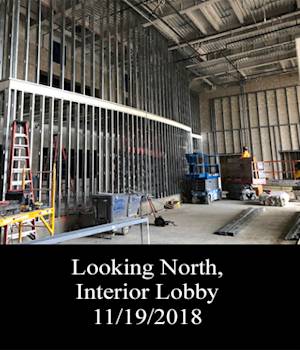

Auditorium Area: The overhead utilities are wrapping up this last week of November. The drywall will be start to be hung in the theater. The lobby plaster is being installed and the ticketing booth is being framed.
East/West Southern Area: Level 1 ceiling tiles are installed, the marker boards installed, and the lab casework is currently being installed. Level 2 marker boards are installed, the casework is starting to be installed, the ceiling grid is installed and utilities, seismic wires and compression posts are being installed.
Southern Most Area: Level 1 casework is installed, the ceiling grid is installed and utilities, seismic wires and compression posts are being installed. Level 2 prime and first coat are beginning. The ceiling grid is to start next week.

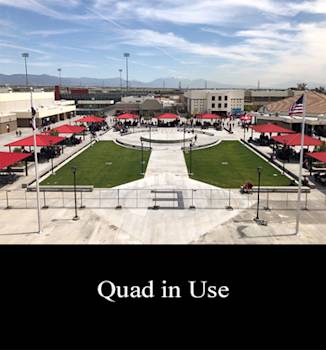

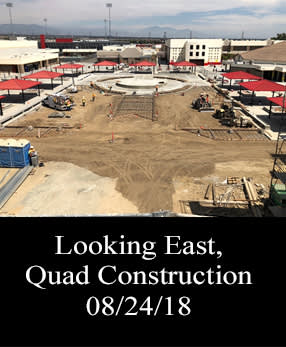

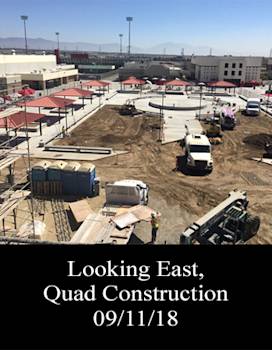

Quad: The quad construction activities are complete and the SE corner of school will be opened up. We will be working through punchlist items through December.

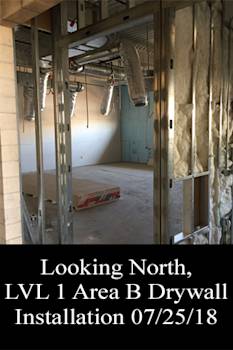

Northern Most Area : Level 1 drywall and texture is complete and paint is beginning. Level 2 fireproofing is complete and metal stud framing and all overhead utility activities are taking place.

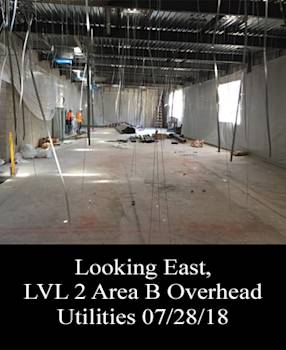

East/West Northern Area: Level 1 Acoustical ceiling grid is installed and all ceiling utilities are dropped. Ceiling tile is beginning to be installed. Level 2 Drywall is textured and painting is starting.

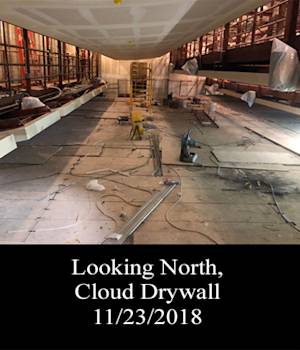

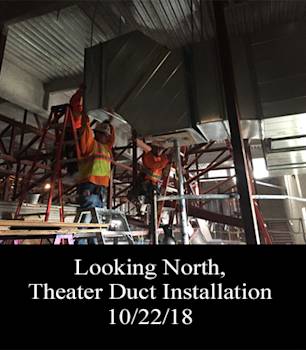

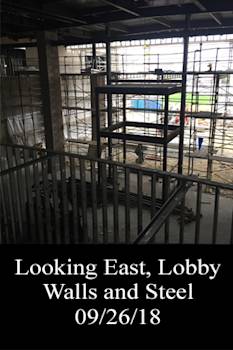

Auditorium Area: Over head utilities are being installed in the theater, the catwalk plywood is being installed and the framing is taking place. The lobby overhead utilities are being installed and framing is taking place.
East/West Southern Area: Level 1 Acoustical ceiling grid is installed and all ceiling utilities are dropped. Ceiling tile is beginning to be installed. Level 2 drywall is currently being completed and tape/mud/texture is starting.
Southern Most Area: Level 1 drywall is textured and painting is starting. Level 2 drywall is almost done being hung.

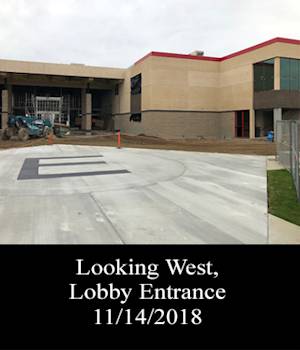

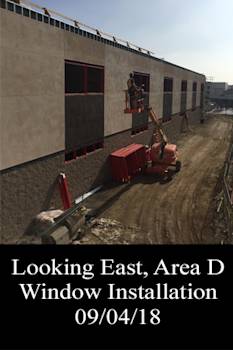

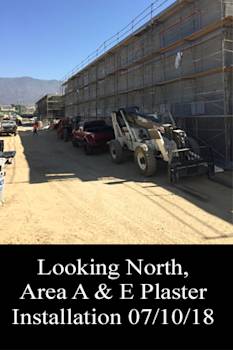

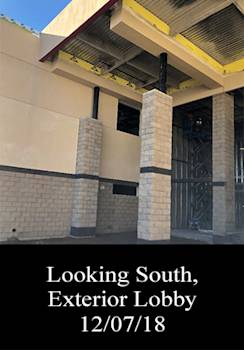

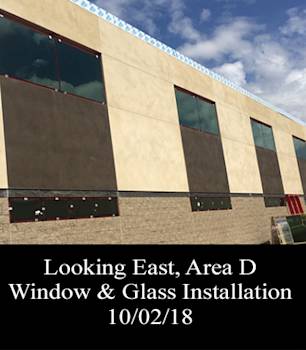

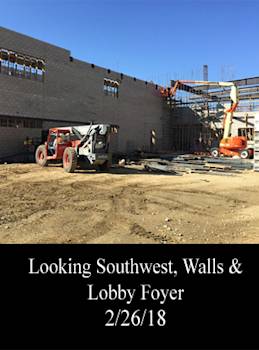

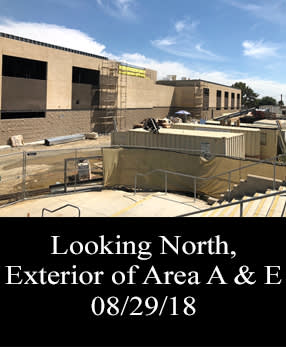

Exterior: Window and glass installation is 80% complete. Plaster is 90% complete. Roofing is 95% complete. Lobby exterior is framed out and lath is being installed.

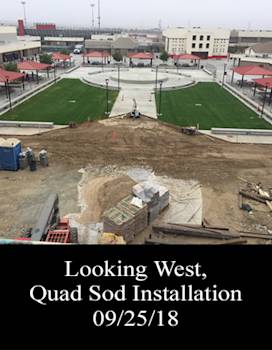

Quad: All ramp walls are poured and back filled. The ramp slabs are poured. Light poles and irrigation main lines are installed. The last bit of slab for the stairs at the front of school will be poured in November.
In the Northern most area, the roofing is almost complete. The framing and overhead utilities are complete and is ready for drywall on level 1. The overhead beam clips and hanger wires are installed and ready for fireproofing on level 2. The Northern area runs East/West and the roofing is complete. Level 1 painting has started. Level 2 walls are complete and the overhead utilities are almost complete. In theater area, the roofing is complete over the theater stage and lobby. The theater fireproofing activity is taking place. The lobby walls are being framed and the lobby soffit framing is taking place. The southern area runs East/West and Level 1 painting has begun. Level 2 walls are built and drywall is hung. The overhead utilities are almost complete. In the Southern most area, the walls and overhead utilities are complete and drywall is starting on Level 1. The fireproofing is progressing at Level 2. The plaster has made significant progress this month. The window frames are progressing with a substantial portion of the windows complete. A portion of the glass is onsite and ready to install. The quad sod is installed and we have turned over a portion of the quad. Retaining walls have been poured at the Southeast corner of the quad.

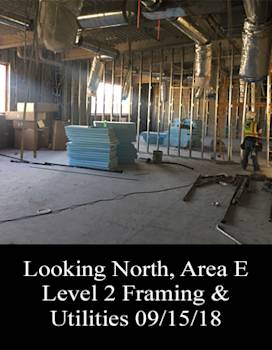

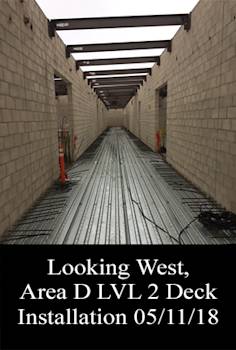

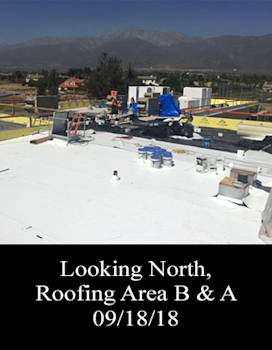

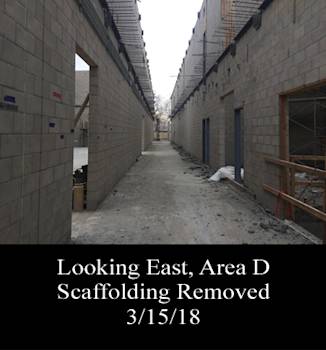

Roofing has begun on the northernmost section and the 2nd level deck is poured. Fireproofing is complete for the second level beams. The metal stud framing has begun on the first level. Roofing is progressing on the northernmost area running east and west. The first level drywall finish has begun while the second level overhead utilities and framing are progressing. The auditorium section has the metal decking complete at the theater and lobby. The scaffolding is built in the theater. The low walls are framed and overhead beam hangers are being installed. Roofing continues at the southernmost area running east and west. The first level drywall finish has begun while the second overhead utilities are nearing completion. Roofing has begun on the southernmost section with the second level deck poured. Fireproofing is complete for the second level beams. Metal stud framing is almost complete and overhead utilities are starting. The plaster on the outside of the building is progressing with color application process ongoing. There are some locations at the end of the corridors, lobby and back side of stage walls that still need to be completed.
The quad shade structures are complete. The perimeter fencing and hardware are complete. The concrete flat work is nearing completion with only a few more pours required to complete the quad. The sod is scheduled for the first week in September. The second phase of construction has begun on the SE corner of the campus entrance. Demolition is complete and rough grading is taking place.

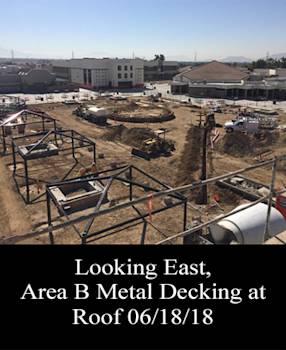

Area North and South running section of the building have the roof metal decking complete. The HVAC curbs are installed and plenums dropped. The Southern most section on Level 2 decking is complete and the deck inserts are starting. The overhead utilities of the Southern section of the building that runs East West are complete and all walls are framed. On the 2nd level, fireproofing is complete and overhead utilities are starting. The overhead utilities of the Northern section of the building that runs East West are almost complete and all walls are framed. On the 2nd level, fireproofing is taking place. The roof penetrations are complete for both the above areas and the roofing activity is in preparation. The slab in the theater is poured and the scaffolding is being erected for the theater dance floor. The lath is installed all around the building and scratch coat is being installed.
The quad perimeter concrete is complete and the campus already has the agreed upon area for student access. The planters are poured and backfill and fine grading has started in the center quad. The shade structures have started to be installed. Light poles are being installed where students have access.

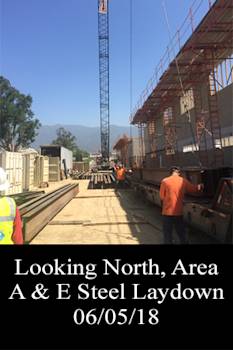

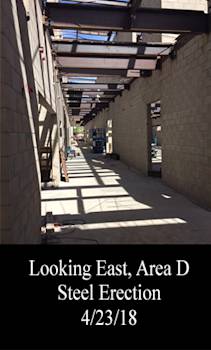

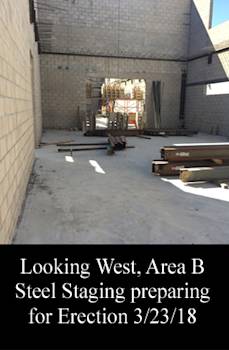

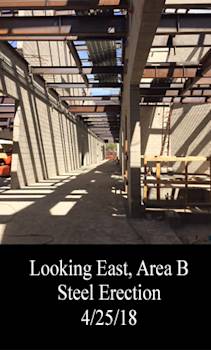

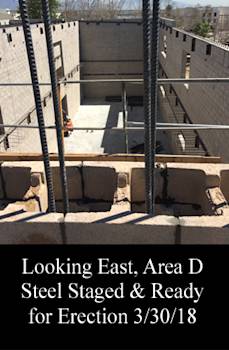

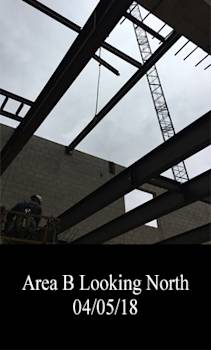

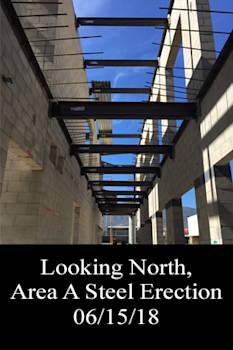

The NW Area section steel is installed and welding is 50% complete. The North Area roof deck is complete, Level 2 deck is poured, Level 1 wall exterior wall furring has begun and fireproofing is taking place. The auditorium steel catwalks and clouds are installed, the lobby steel is erected, and the theater electrical floor boxes are being installed. The South Area Level 2 deck is poured, the metal decking on the roof is complete, fireproofing Level 1 beams is complete at area North & South, Level 1 overhead utilities have begun, and Level 2 wall furring has begun. The SW Area steel is installed and welding is 50% complete. The main sewer and storm drain lines are being installed at the front of the campus. The Edison yard switch gear has been installed and the fencing is installed. The main feeders for the new Edison yard are pulled and being landed. The site concrete along the campus A and C buildings are demolished, graded and poured back. The new fire road at the north side of the campus is graded, the curb is poured, and the asphalt is installed.

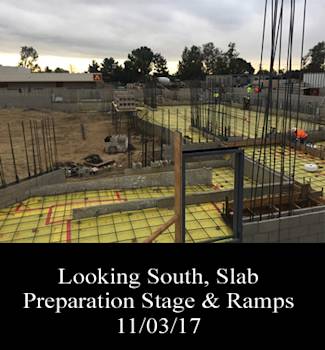

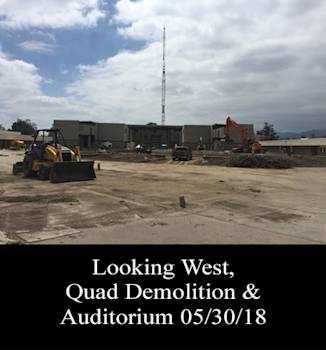

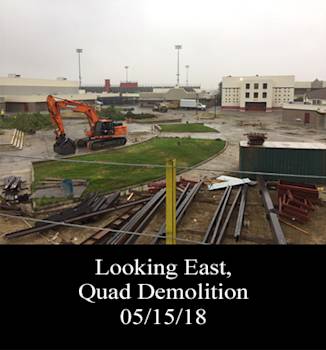

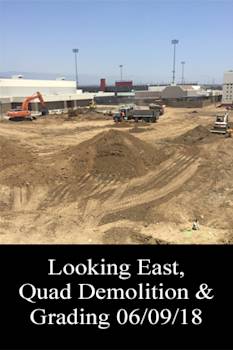

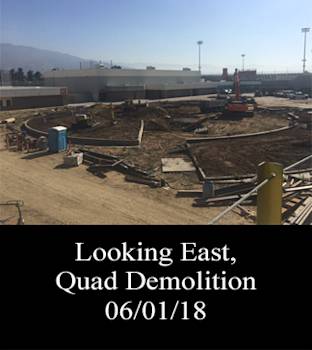

The quad is demolished and the rough grading is complete. The footings are dug, the rebar is installed and a few footings have been poured. Flat work has started in the SE corner of the quad. The irrigation main line, the electrical underground, and the new storm drain lines are installed.

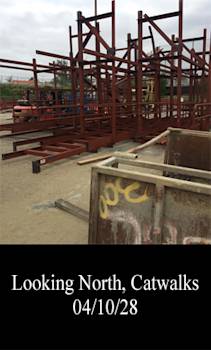

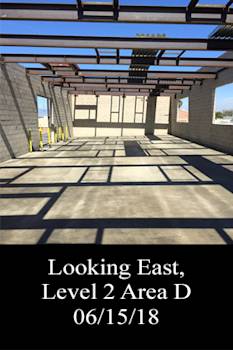

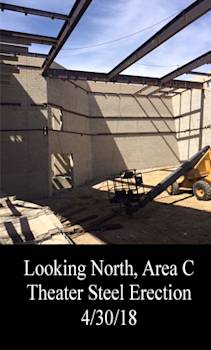

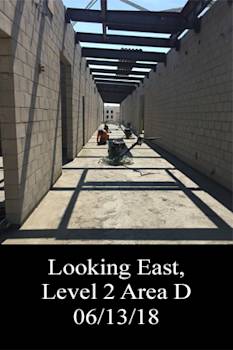

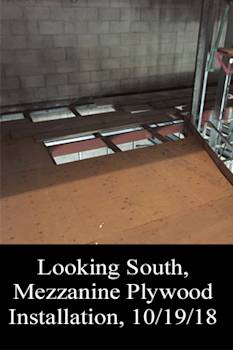

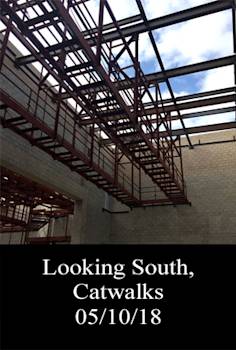

Roof steel, catwalks and clouds are installed but not welded in the theater. The metal decking is complete on Level 2 D and decking has started Level 2 B. CMU is complete at area North and South position wings and scaffolding is removed. The crane has mobilized to the west side of the project to begin erecting area of the same sections. The Edison yard electrical infrastructure is complete and the yard slab is being poured. The sewer and storm drain installation at the front of the campus has begun. The trees have been removed and demolition has begun in the quad.

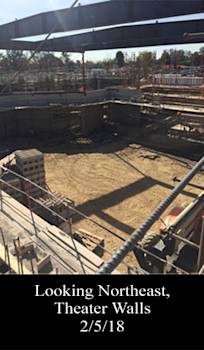

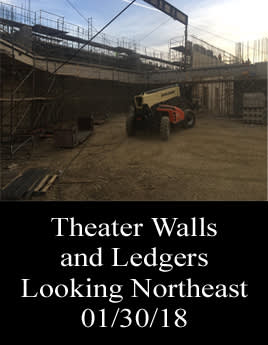

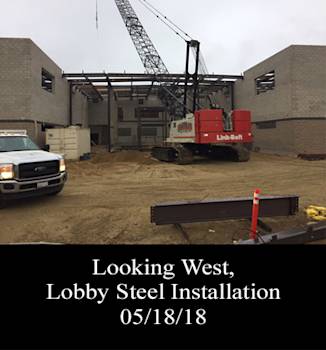

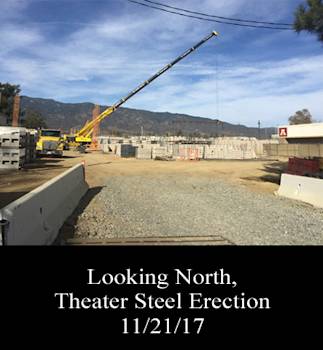

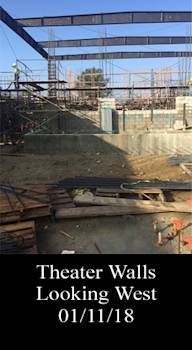

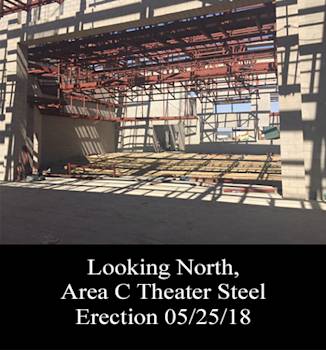

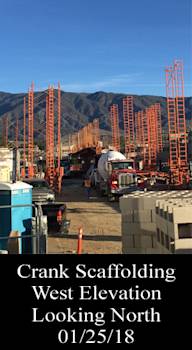

Steel is erected at building sections running east and west. Metal decking is starting in building sections running east and west. Theater walls are topped out at 40′ and scaffolding is removed. Theater roof steel, catwalks and clouds are starting. Building sections running north and south have walls 24′ high. Domestic water and fire is connected to the street. New electrical feed is connected to the street and new infrastructure to the building is installed.

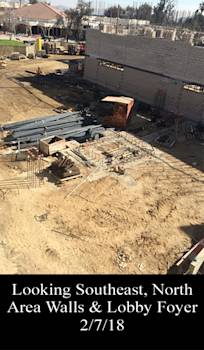

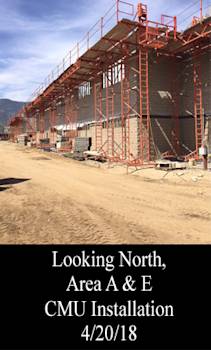

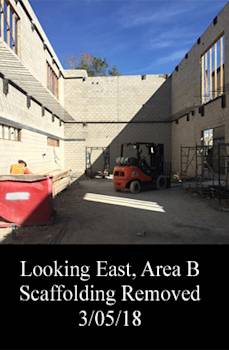

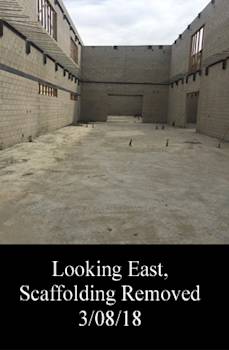

The building section to the North is complete with masonry and scaffolding is removed. The building section in the middle area is complete with masonry, and scaffolding is removed. The building section to the South is grouted up to 26′. Most northern and southern sections are progressing and are at Level 2 embed elevation. Work began on the new permanent power yard and the water distribution is working towards the connection out on Victoria Street.

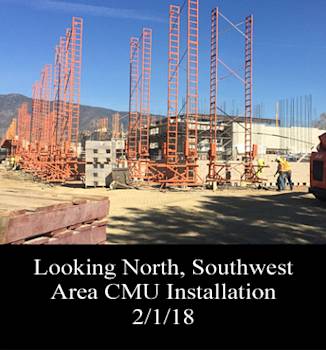

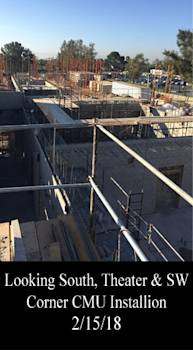

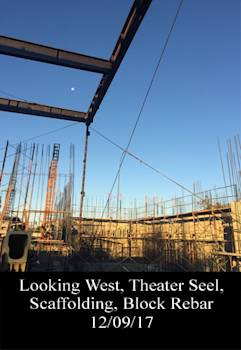

The North side CMU block is topped out at 30′ and has been grouted. The roof embeds are set and scanned. The auditorium section is grouted up to 24′. The South area has CMU block installed up to 28′ and the roof embeds are installed. The Northwest Area CMU is at 20′ not grouted. The Southwest Area is up to 8′ not grouted.
The north main corridor wall running east/west corridor is grouted up to 24′. The north main east/west corridor south wall is up to 24′ but not grouted. The auditorium area is at 16′ and embeds are installed ready for grout. The wing area south is at 20′ but not grouted. The Southern wing area E slab was completed and block is installed up to 4′ but not grouted. Site domestic and fire water are being installed to the back of sidewalk. Street tie preparation is underway for a projected tie in over spring break.
All embeds on Level 2 north side are installed and ready for grout. Over half of the embeds for Level 2 south side are installed. A section of the Walls at level 2 are at 16′ high. The walls that are 16′ embeds are currently being installed. Walls in the theater section are 6′ high.

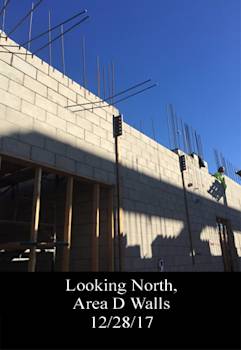

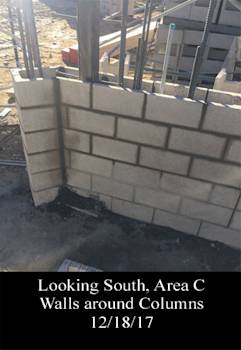

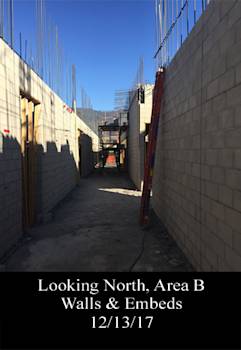

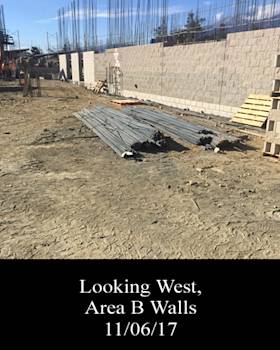

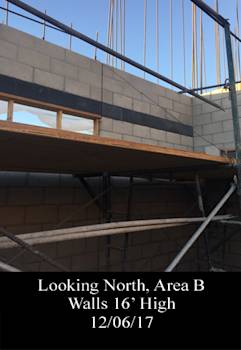

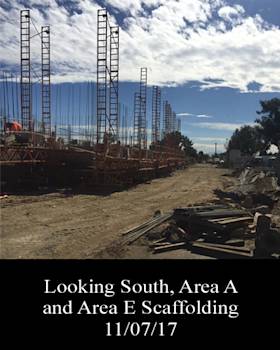

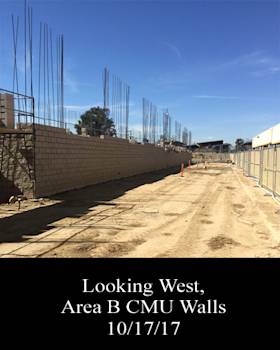

The area B walls are at embed elevation. Area South walls are 12′ high and grouted. Area Northen most walls are 12′ and grouted. Area Southern most walls are 4′ high and not grouted. The theater columns, beams and girders are installed. CMU walls in the theater are beginning to go up.

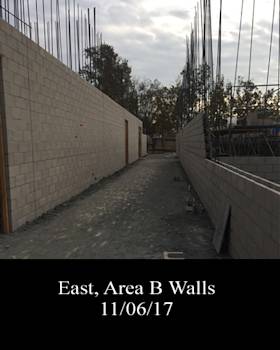

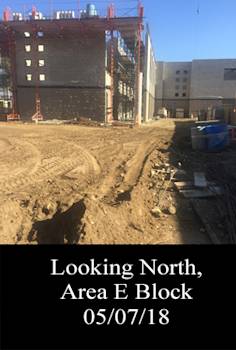

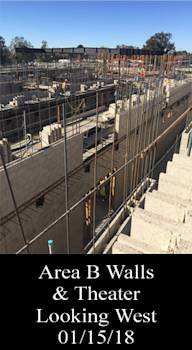

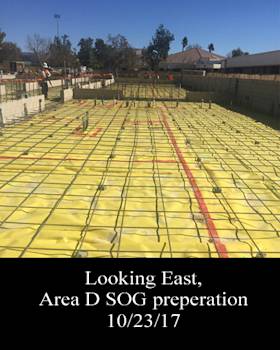

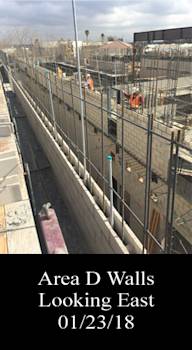

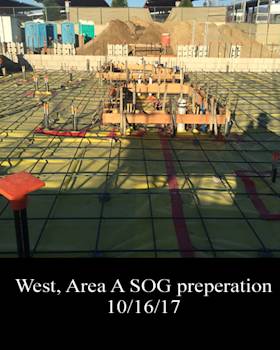

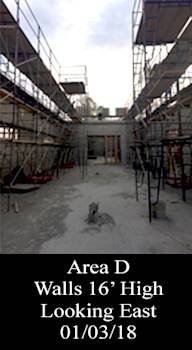

The building slab has been poured on A, B, D and some of E. Walls are 12′ high on building B North side of the corridor. Walls are 4′ high at every other part of the project. The stage area wall has been poured and backfilled. Trades are currently working on underground and slab prep for stage slab on grade. The remainder of building E footings are being excavated and templates installed. We are also working around the perimeter for storm drain connections and installing firewater, water and sewer.

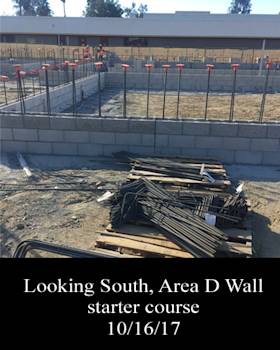

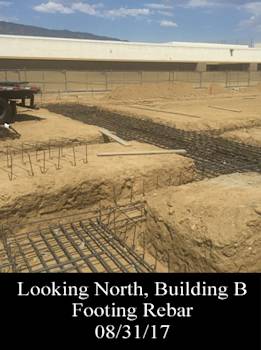

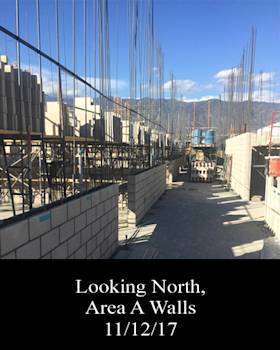

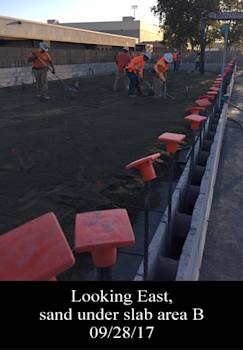

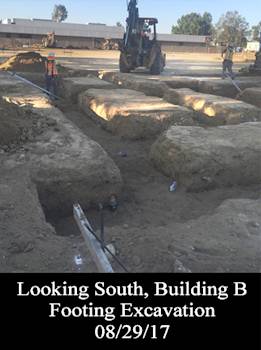

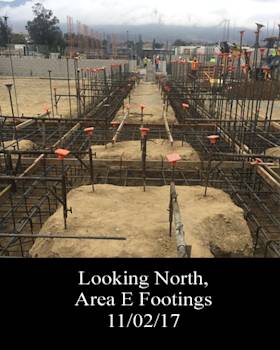

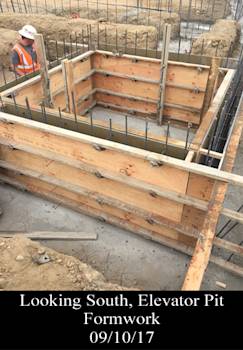

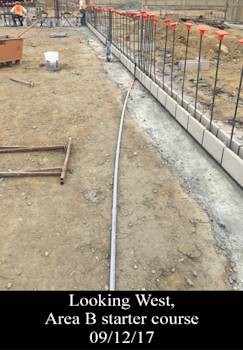

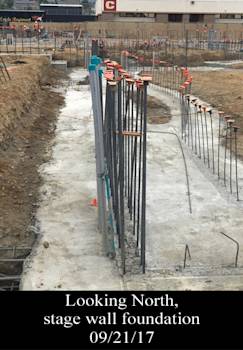

Footings for A, B, C D and half of E were excavated, rebar installed and poured. The first course of masonry is being installed as well as B, C and D. The elevator pits have been poured. The stage wall footing have been poured and the walls are being formed. The under slab work for B is complete and ready for sand and vapor barrier. Steel column and beams are being fabricated for the middle theater.

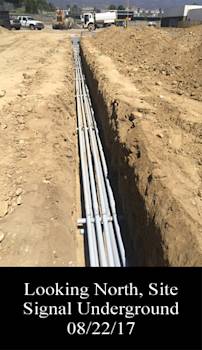

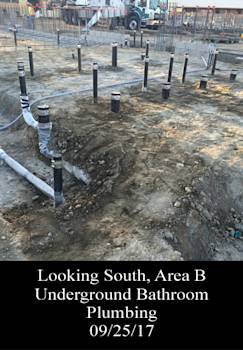

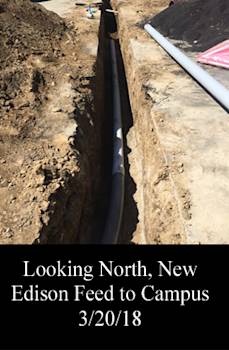

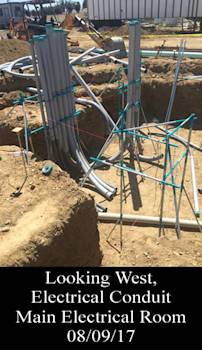

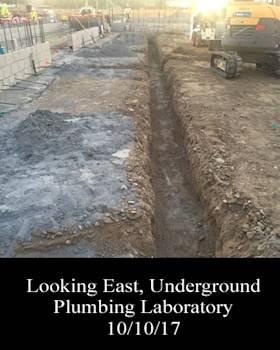

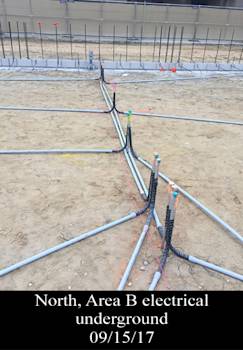

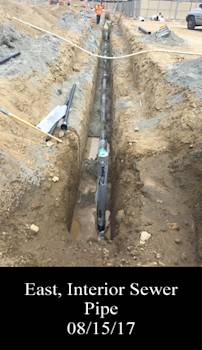

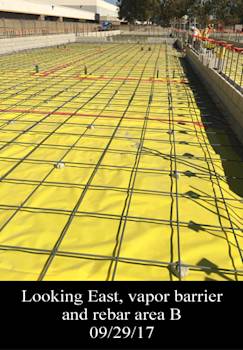

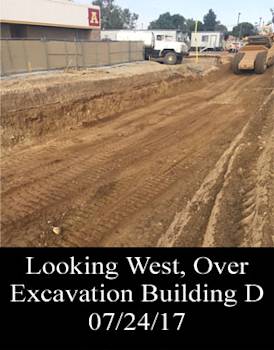

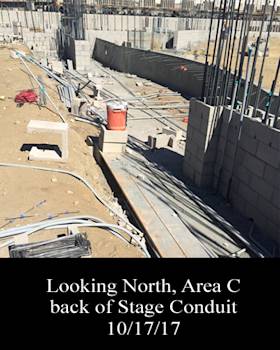

Underground building electrical and plumbing has been installed. The building footing excavation for building B, D & C has started. The site signal undergound is 75% complete. The site sewer north of building B is complete. The site fire line and storm drain south of building D is complete. Footing excavation at building B has begun and rebar is being installed in the footing.

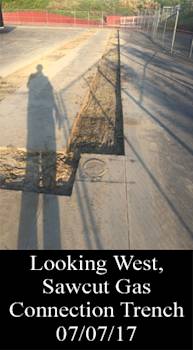

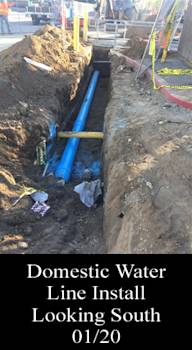

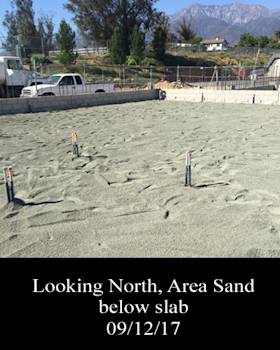

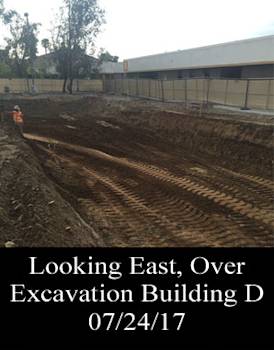

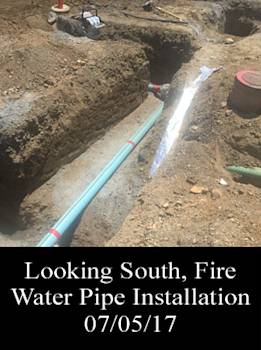

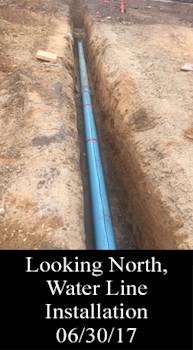

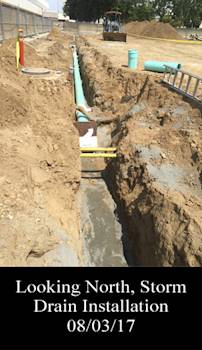

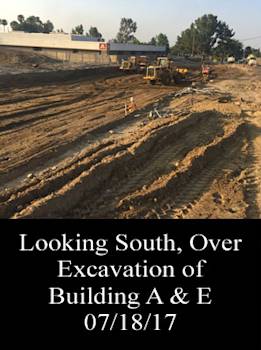

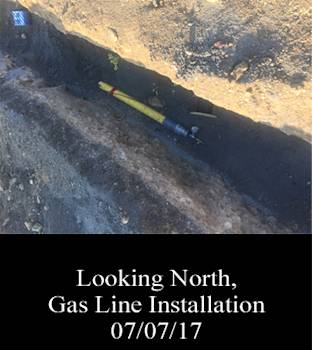

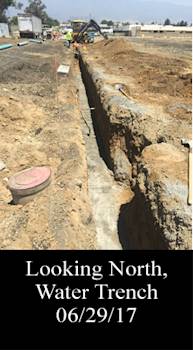

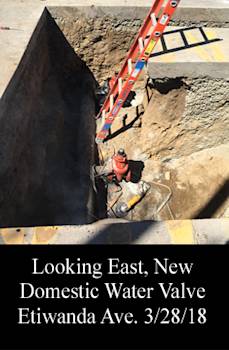

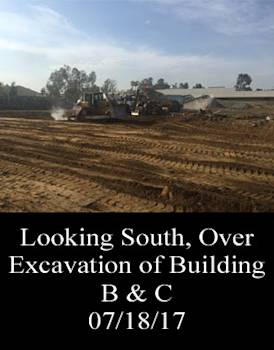

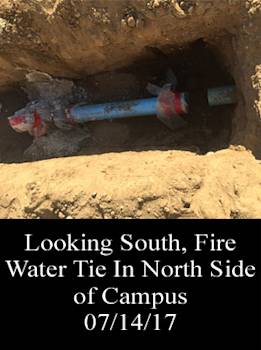

The underground domestic water, fire service and gas have been re-routed and tied back into the existing lines. The over excavation activity has started and will be completed by the end of the month. Pad certification is complete and electrician and plumbing contractors are preparing to start the building underground early August.

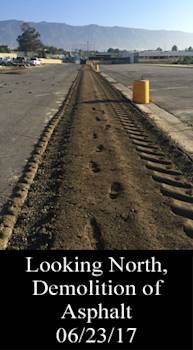

Construction management team mobilized and set up construction fence. Contracts were board approved on 6/13/17. Demolition began and vegetation was removed. Underground water and gas are being re-routed from under the new building.
