This month all the portables have been set and progressing with the electrical to feed the new interim housing and necessary low voltage for the projectors, fire alarm and data.

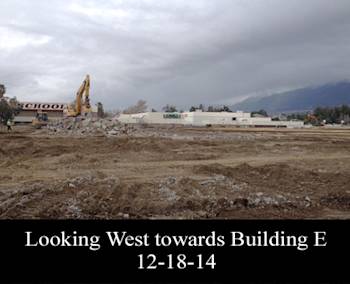

The demolition of the existing structure is bid and pending the relocation completion in August.
The project has advanced through to the completion of the finishes and has been turned over for occupancy. The project was completed for the dedication ceremony that took place on February 16th. The campus has started using the Stadium and Track area since the dedication ceremony.

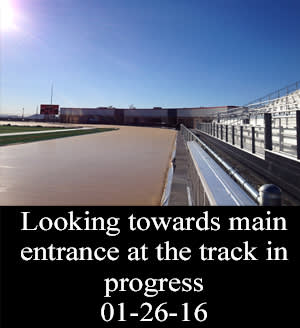

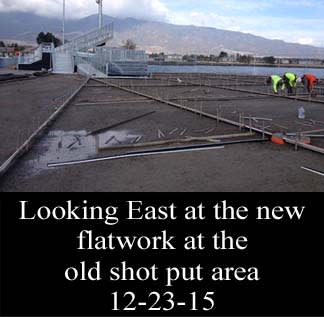

The project is progressing with finishes including the flooring. The mechanical, electrical and plumbing fixtures are in progress. Final coat of paint is being installed on all surfaces of the exterior. Metal soffit panels at the ceilings are complete. The remaining site work is the shot put area and the ADA parking on the west side of campus has commenced. Track surface installation is progressing.
The project has advanced through the drywall installation and first coat of painting on the interior and exterior of the building. Plumbing fixtures are being installed as well as light fixtures in the health classrooms and restroom areas. The ceramic tile installation is complete. On the exterior of the Concessions Building, the remaining flatwork around the building was poured. Installation of the metal soffit panels and metal panels at the ticket booth are progressing. The drywell installation is complete and the system connected. Track surface installation is progressing.
The project has advanced through the framing of walls and rough-in of the mechanical / electrical and plumbing trades for the Concessions Building. Roofing is complete. Painting of the exterior walls has progressed. The mechanical equipment has been installed on the roof and is currently being connected / terminated. The next milestone for the project will be hanging of the drywall so that the finishes can be installed on the walls. Concrete around the Concessions Building has advanced with two pours to date. The west parking lot improvements are complete and the parking lot has been opened for use.

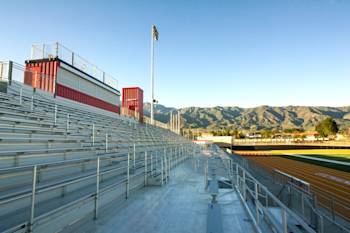

Bleacher installation is topped out and complete. The team is focusing on completing a walk through and punch list for the bleachers.

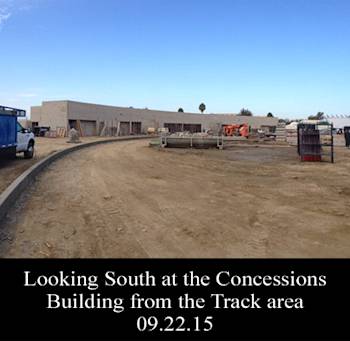

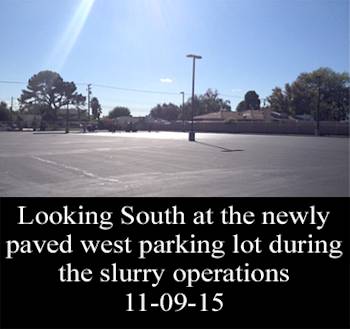

The project has progressed through the installation of the structural steel and metal decking for the Concessions Building. The building is currently being wrapped in lath in preparation for the plaster installation. Interior mechanical, electrical and plumbing trades are continuing with their above ceiling installation. The framer will then proceed with the installation of the ceiling and wall framing. The marquee sign has been installed. The West parking lot improvements are pending the slurry and striping.

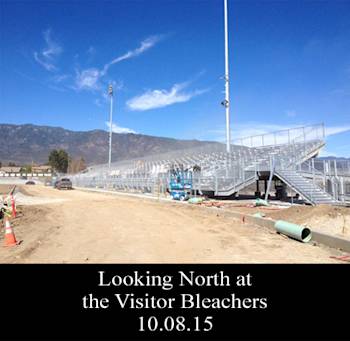

Bleacher installation has the planking complete with the installation of façade and railing in progress.

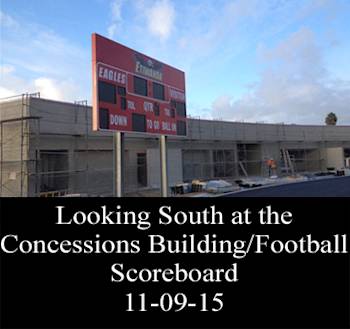

The project has advanced the top out of the Masonry on the Concessions Building and has progressed forward with the under slab electrical and plumbing work. Installation of structural steel has commenced. The grand staircase has been poured as well as the marquee sign footings and columns. The scoreboard for Varsity Softball is installed. Work is advancing on the installation of the Varsity Baseball scoreboard. The West parking lot improvements are advancing with the paving of the new parking lot.
Bleacher installation is progressing with the Visitor side working on the trim out. The home side bleacher has the planking for seating and risers completed this month.
Gym Bleachers: The scope of work in the gym and restrooms is complete. Punch list corrections of these areas are advancing. The switchback ramp at the front of the campus has progressed through the wall pours and has started with the backfill of the area.

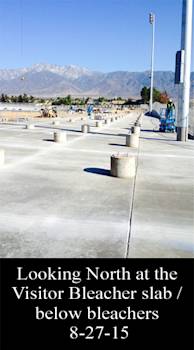

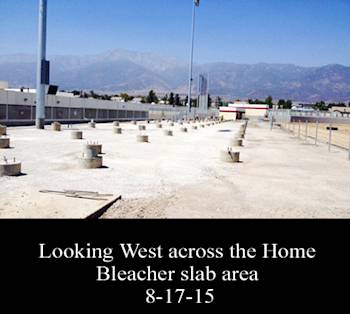

In the Stadium, the concession building has started and the concrete flatwork below the bleachers on both the home and visitor sides is complete. Elevator is set. Installation of the bleacher systems has commenced.

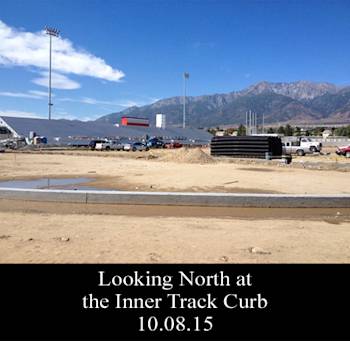

At the West parking lot, installation of the underground electrical and irrigation is advancing. The parking lot is currently graded for installation of the sub base to begin. Chain link around the perimeter of the parking lot is complete.
Gym Bleachers: The scope of work in the gym and restrooms is complete. The switchback ramp at the front of the campus has progressed thru its first concrete pour for the wall footings.

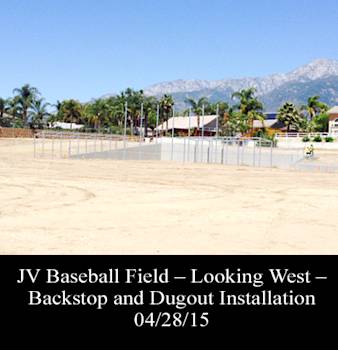

Currently the project has completed and turned over the JV/Varsity Softball Fields and the JV Baseball Field as well as the Tennis Courts and Basketball Courts. The Concessions Building has begun with the excavation of the footings and rebar placement. The football field has been graded and bleacher footings are complete.

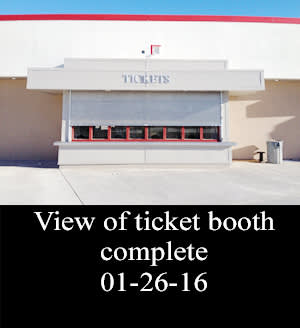

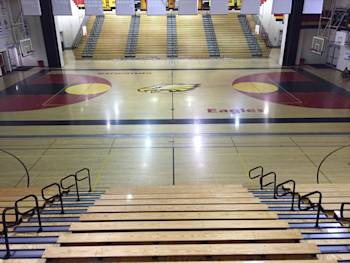

Gym Bleachers: Installation of the gym bleachers have been completed as well as the ADA revisions in the men’s and women’s restroom adjacent to the restrooms. The pass through window and coiling door at the ticket booth window is advancing.

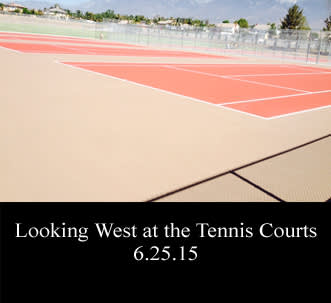

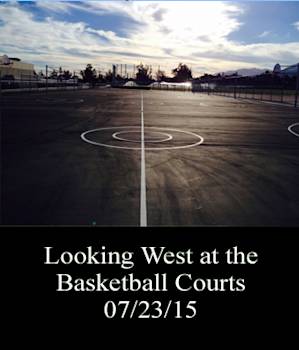

The project has completed the large portion of the retaining walls. The last of the retaining walls has commenced. This will establish the grade at the parking lot. The sod installation has completed on 3 out of 4 fields. Sod for the Varsity Baseball Field is in progress. Installation of the foul pole netting also completed this week. Athletic Equipment installation is progressing. Tennis court surfacing is complete.

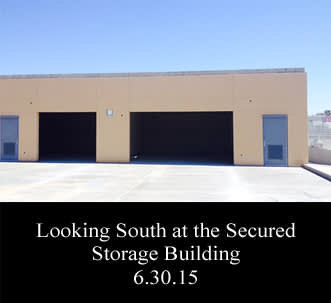

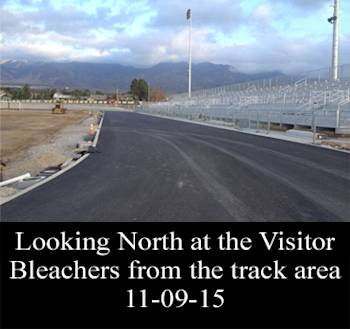

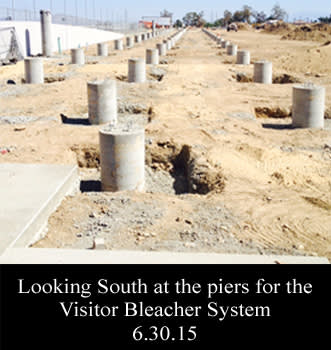

In the Stadium, the visitor bleacher footings were poured this month. Grading for the flatwork at both bleachers will begin next month. Installation of the perimeter fencing is advancing on the East Property Line. The Track Storage and the Secured Storage Buildings have progressed with stucco installation. Roll-up doors are complete at track and storage buildings. Concession Building footings have begun.
Gym Bleachers: The demo of the restrooms and bleachers is complete. The new bleacher system arrived this month. Materials have been moved and stocked in the gym. Currently plumbing lines are being relocated in the restrooms for ADA upgrades. The new ADA ramp at the front of the campus is also in progress with excavation for the ramp and footings.

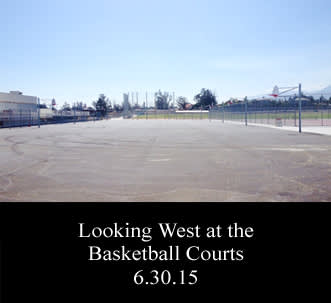

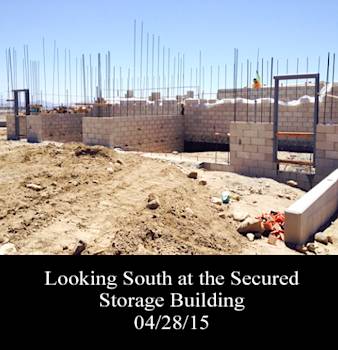

Twelve out of the project's thirteen retaining walls have been poured and backfilled. The JV/Varsity Softball Field fencing and infields are prepared for sod. Flatwork around these fields has also been poured and grading is being completed in preparation for sod installation. Tennis courts have been poured. Fencing is being installed for the perimeter. Basketball backboards supports are installed. The Track Storage and the Secured Storage Buildings have progressed with underground work and slab prep. Structural steel has been installed. Stucco has started for both buildings. Metal Decking has been set and will be welded off once the slab is poured. The Varsity Baseball field is being graded for soil amendments.
In the Stadium area, the home side bleacher footings have begun and will be ongoing for the next 2 weeks. Backfill for the large retaining of the Concessions Building is in progress. All electrical and storm drain has begun installation in the track and field area.
Gym Bleachers: The layout and demo of the existing partitions has begun. Layout of the new ramp in front of the campus has also started in preparation of demo to begin.

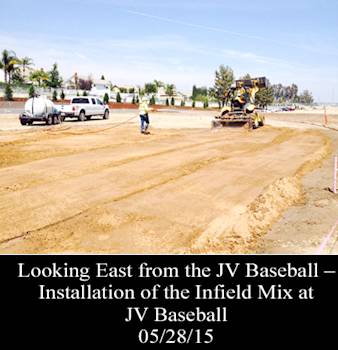

The project has advanced significantly with the retaining wall completion. Eleven out of the project's thirteen retaining walls have been poured. The completed wall systems are progressing with backfill. Grading for the fields has advanced. The CMU for the Track Storage and the Secured Storage Buildings have been completed and grouted. Pre-slab work will advance in preparation for slab installation. Structural Steel will be installed within the next two weeks. On the fields, the backstops, dugouts and field fencing has progressed. Irrigation lateral lines are currently being installed. The first of several loads of planting started delivery on 05/08/15.
The project has advanced significantly with the retaining wall completion. Nine out of the project's thirteen retaining walls have been poured. The completed wall systems are progressing with French drain installation. Grading for the fields has advanced. The footings for the Track Storage and the Secured Storage Buildings have been completed. Fencing in specific areas has started. Installation of the irrigation main lines has begun.

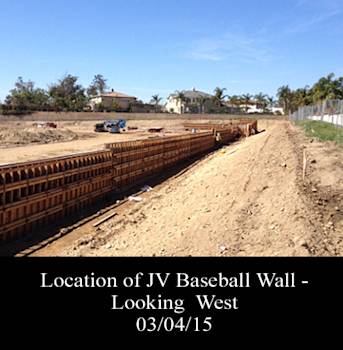

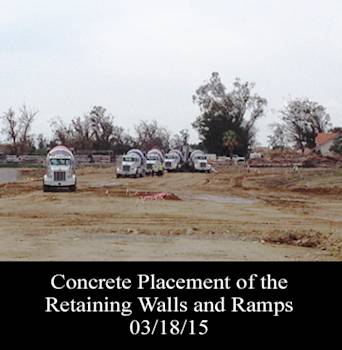

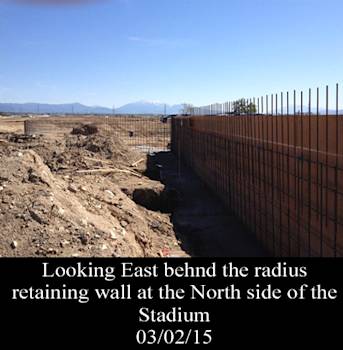

The 2 out of the project's thirteen retaining walls have been poured. These 2 systems are for the walls at the pedestrian ramp to the stadium and the wall adjacent to the basketball courts and JV Softball. Footings for the wall adjacent to the fire lane have been poured and the wall rebar installed. Formwork will commence in a week. Footings for the radius wall at the North side of the stadium have also been poured and wall rebar installed.

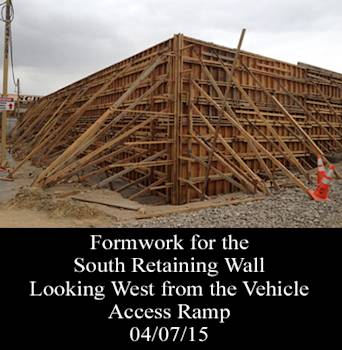

Formwork has commenced. Two wall systems are being formed and will be poured by the end of the week. Progress is being made in re-excavating footings on the south side of the project that were filled with water by the recent rains. With the concrete pours that occurred in February, over 1120 cubic yards of concrete were placed. Over excavation and re-compaction for approximately 500 linear feet of wall remains to be completed. The stormtech chamber system installation is in progress. The Grading Contractor will begin balancing the site and moving the stockpiles to set grade for the fields.
The first retaining wall has been poured. Footings for another 600 linear foot wall have been excavated and rebar is being installed. Footings for these walls will be poured as soon as rebar installation is complete. With the footing pours that occurred in the month of January, over 250 cubic yards of concrete were placed. Over excavation and re-compaction for approximately 2000 linear feet of wall was completed. The Grading Contractor is advancing the balance of the areas remaining for the over excavation and re-compaction of the retaining walls.

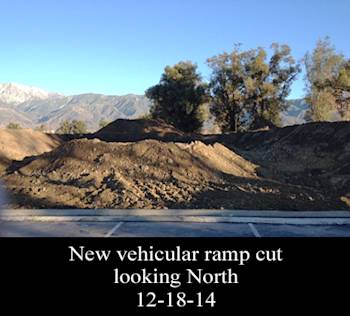

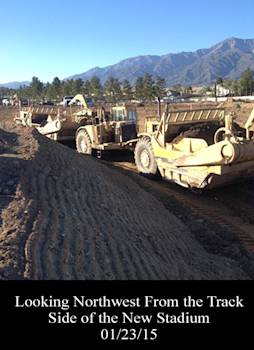

The demolition of the hardscape and softscape is in progress. The Grading Contractor has begun over excavating and re-compacting the area for the first of several retaining wall systems. The SWPPP is in place along with the temporary fencing. The vehicular ramp area on the south east end of the project was cut to grade and will have the base and rumble plates installed to establish the primary means of access to the project site.
