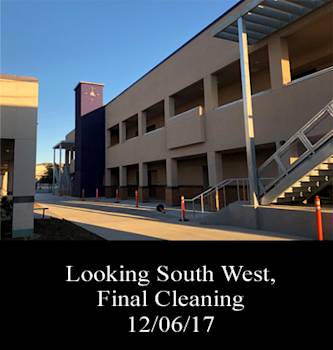

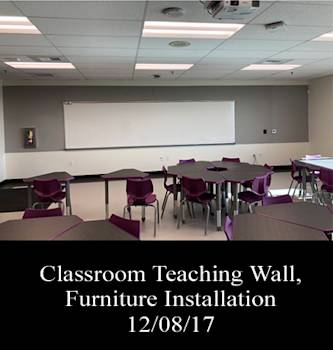

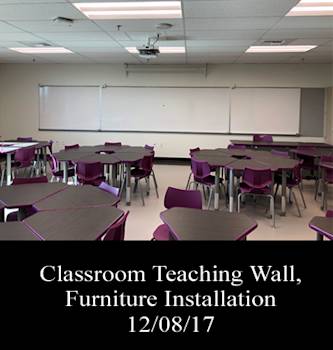

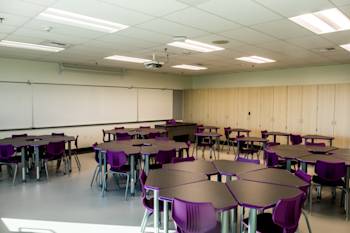

In the month of November all finish trades completed their scope of work and building was punched, commissioned, and tested. Trade contractors are currently making finish corrections and cleaning up the building preparing for the school to occupy. Furniture has also now been placed inside of the classroom. Landscaping is ongoing.

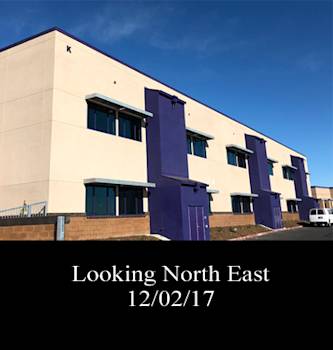

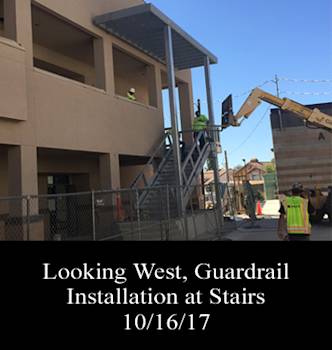

Exterior: Painter is finishing the last of the antigraffiti coating and painting of HM Doors and Frames. Parapet coping is being installed. Hardware is being installed along with the Salto (Wireless Security Access) locks for the building. Stair railing is ongoing at the 2 sets of stairs.

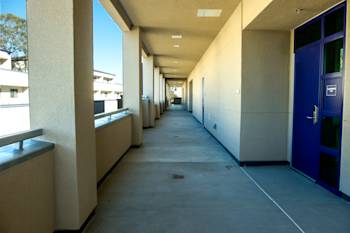

Interior: Casework is being finished up on the 2nd floor. Flooring will start on the first floor. Concrete contractor is pouring the upper level walkway. Fire Alarm/AV/IT Finish Trim is ongoing. Fire Alarm Programming is in progress in preparation for Fire Alarm Testing on Veterans Day. Elevator contractor onsite now testing elevator functionality and start making adjustments to schedule state inspection. All final testing/inspections/punchlists scheduled for the week of Thanksgiving.

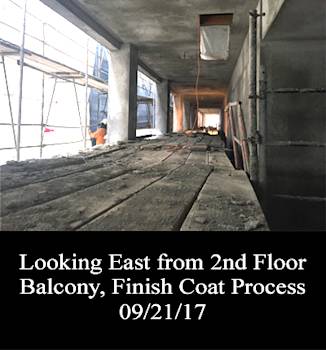

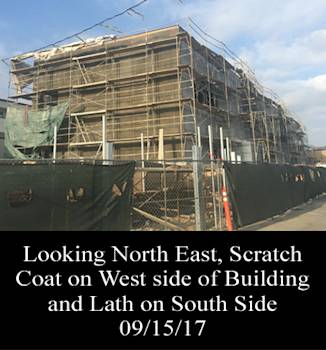

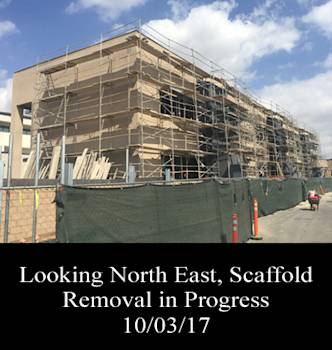

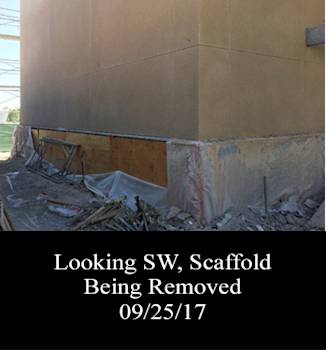

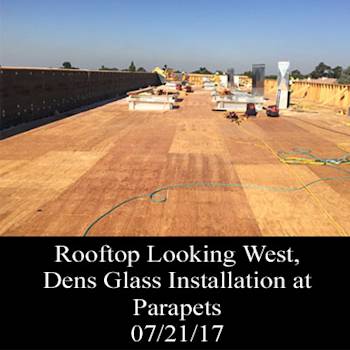

Building plaster process was completed at the end of September. The north, east, and west sides were about 1 week ahead of the south side so scaffold has been taken down on those elevations but not south side. Glass will be installed off of the scaffold so the south side will have scaffold in place for a few more weeks. The ceiling grid has been completed on both 1st and 2nd floors and tile for sprinklers are being cut in on both. Rooftop MEP connections to packaged units are ongoing.

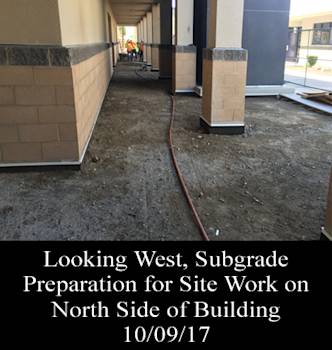

Site: Trash Enclosure walls are currently being waterproofed and will start being backfilled and prepped for concrete slab.

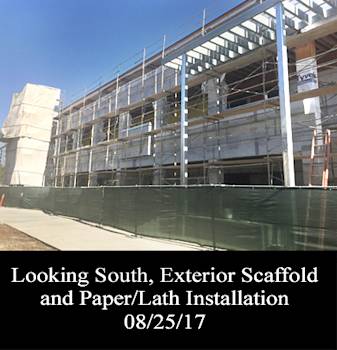

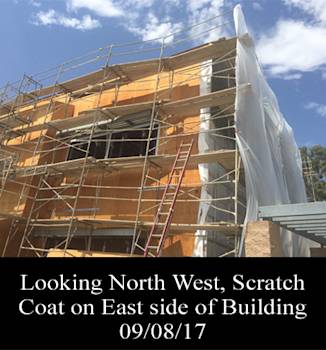

Building: Exterior Finish is underway. Scaffold is being erected with lathers following right behind installing paper and lather getting ready for plaster. The inside of the classrooms are taped and ready for final sand and prepcoat. Once the windows are set the building drywall and trim will be finished around the jambs. Overhead mechanical, electrical and plumbing installations are complete and ready for acoustical ceiling.
Site: Trash Enclosures have been excavated and footing to follow the excavation.

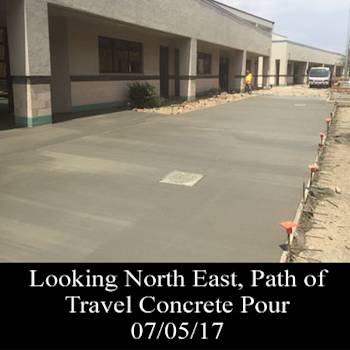

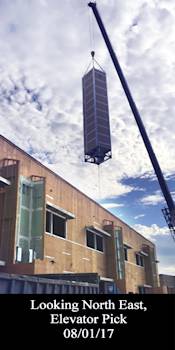

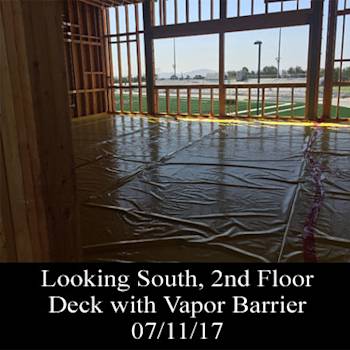

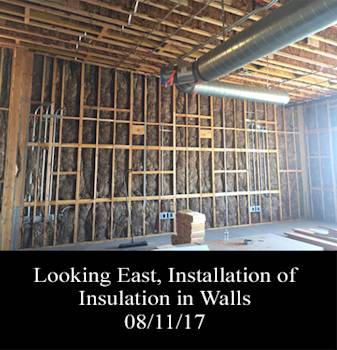

Summer Restrooms Renovations and Concrete Path of Travel work have been completed. Restrooms are opening up for students returning on the 7th of August. Framer is finishing up exterior balcony soffits and balcony wall at elevator. Roofing was completed at the very end of June. 1st Floor insulation and drywall has commenced this month. 2nd Floor Overhead MEP is ongoing. Exterior brick veneer is also complete. Underground feeders for permanent power are currently being pulled and in progress.

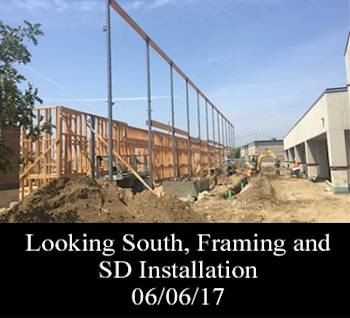

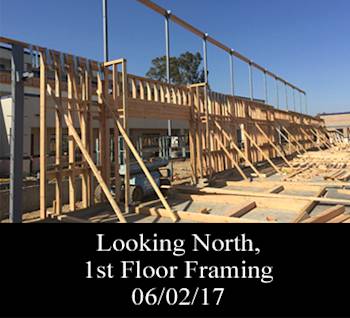

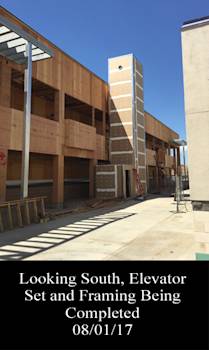

Building Framing is ongoing. Currently Setting Roof Joists and completing framing hardware for first floor. 1st Floor Overhead Mechanical and Electrical installations started mid month. Summer Restroom and Path of Travel Work is ongoing and on track to open up prior to school starting back up in August.

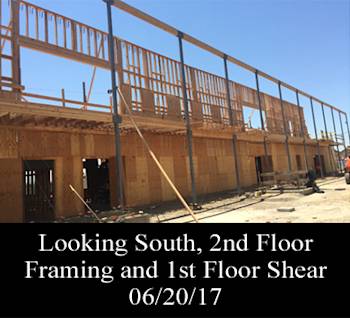

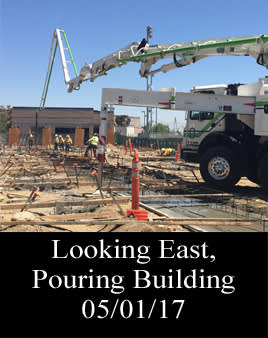

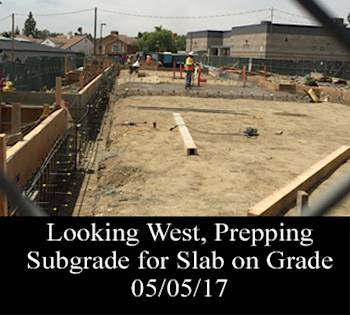

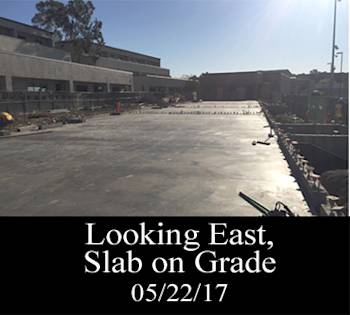

Building Slab underground was completed this month and the slab on grade was poured mid month. The framing layout commenced and building steel erection began this month. Summer Restroom and Path of Travel Upgrades started after classes were out for the summer.

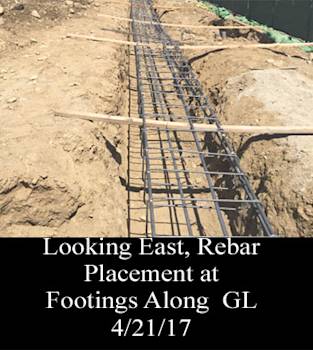

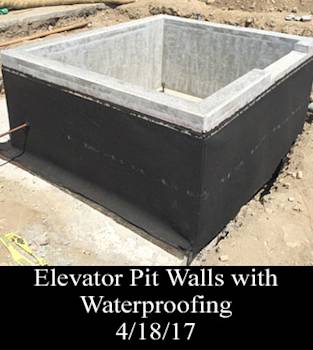

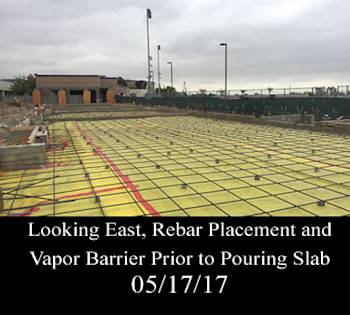

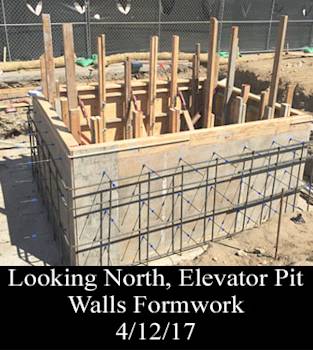

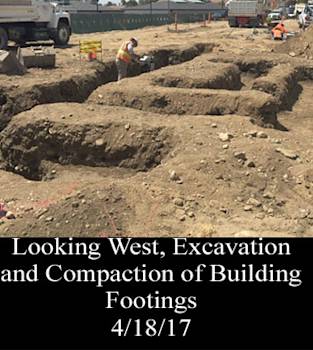

Building underground utilities have been installed. Elevator Pit slab and walls have been poured and backfilled. Footing excavation is ongoing and rebar placement has begun. Foundation placement is scheduled for to start the first week in May.
