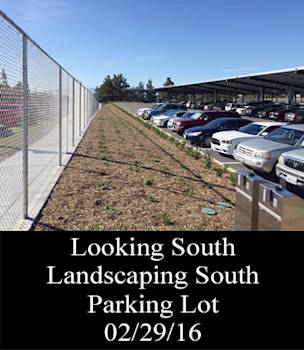

The remaining handrail and guardrail are being installed at the stairs and ramps. The project team is working through a few remaining punchlist items. The City landscaping at Victoria Park Ln is being installed.

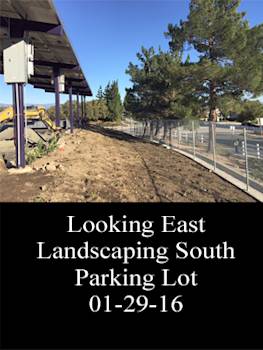

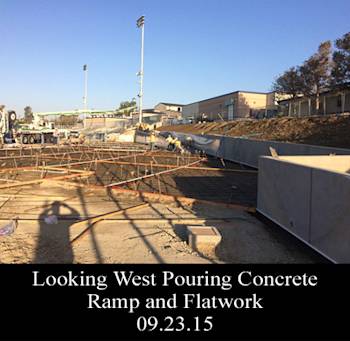

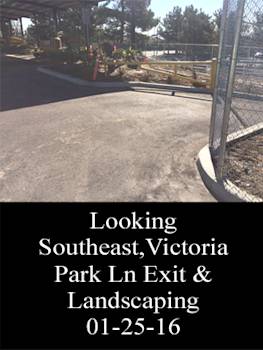

The stairs from the new parking lot to the stadium plaza were completed this month. The new parking lot was striped. The remaining handrail and guardrail are in progress at the stairs and ramps. The landscaping around the parking lot is in the final stages.

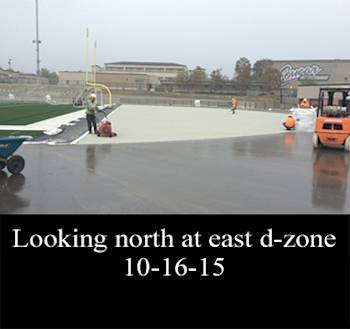

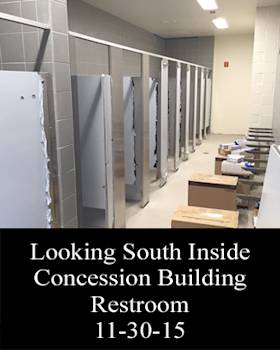

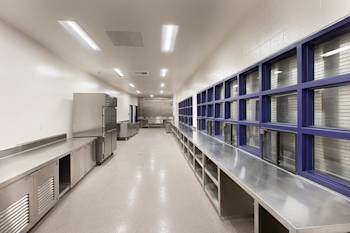

The epoxy flooring in the concession building is complete. The concession equipment is complete. The toilet partitions and plumbing finishes are complete in the conession. The HVAC units have been turned on. The last ramp wall at the SE corner of the stadium is being constructed. The remaining curbs in the parking lot are being formed and poured. The drive approach at Victoria has been poured. Fire Alarm, Security and Data wire is pulled and being tested.

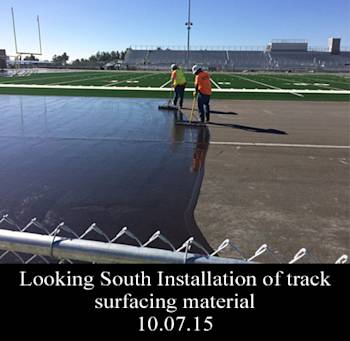

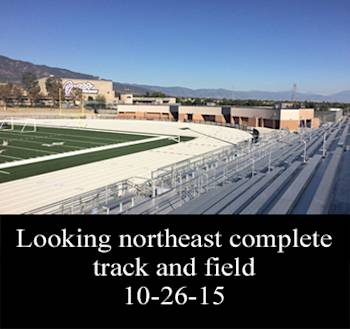

The track surfacing is complete and striped. Building Y T-bar is installed and fixtures are complete. The existing bleacher have the brackets installed for the new benches. The exterior concrete around the concession building is poured. The painting is complete in the conession building. The tile work is progress in the concession restrooms. The metal panels are complete on the exterior. All MEP ceiling trim is currently being installed. The concession building wire is being pulled. The solar is complete in the parking lot crubs can begin.

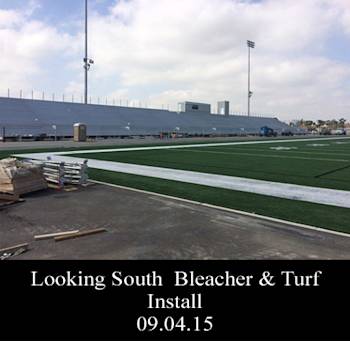

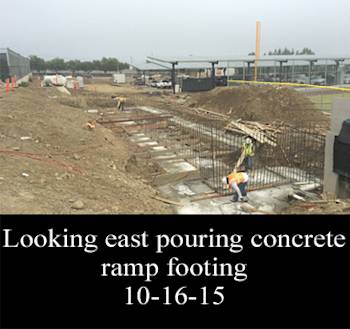

The south bleacher and press box is complete. The concession building drywall is currently being hung and taping has started. The concession roofing is complete and coping is being installed. The HVAC units have been installed and electrical is being hooked up. Building is currently being painted and roofing and HVAC units are complete. All retaining walls along the fire road are complete and flat work on the ramps is being poured. The flatwork on the east side of the concession is complete. The track surfacing has started. The synthetic turf is complete. The offsite work on Victoria Park Ln. is underway with rough grade and forming of curbs.
Present:
-Installing flatwork east side of concession.
-Installing tile in concession restrooms.
-Taping and sanding walls concession.
-Hanging T-bar in building Y.
-Pouring footings for Marquee sign.
-Hanging tube steel fencing.
-Installing track surfacing.
Future:
-Hanging doors concession.
-Painting Interior & Exterior concession.
-Hanging Toilet Partitions.
-Pouring Tennis Court Ramp.
-Pouring Footings for Basketball Court.

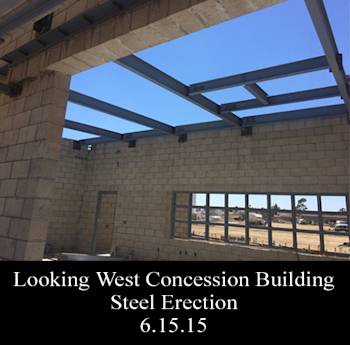

The bleacher steel is complete and aluminum planking is being installed. The concession building framing is almost complete and all utilities are being roughed in. The concession roofing is being installed and exterior plaster system is being installed. Building Y framing is complete and utilities are being roughed in. New roof for building Y is beginning. The last retaining walls along the fire road will be completed. Demolition of the offsite drive approach is beginning. The synthetic turf will be completed by the end of the month.

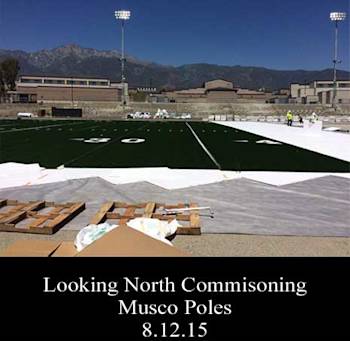

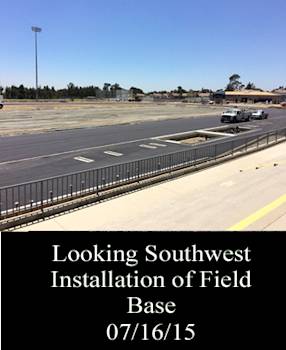

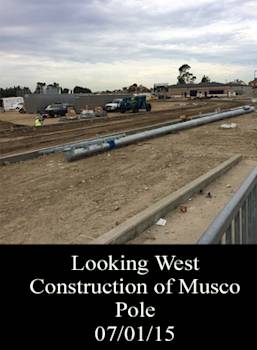

The track has been fully paved. The bleacher footings have poured and undernearth flatwork is being placed. The synthetic turf substrate is complete and ready to install turf. Remaining retaining walls are being worked on. The stadium lighting musco poles have been installed. The concession building metal decking has been installed and framing has begun along with plumbing piping. The building Y roof has been removed and the new structural steel holes have been cut open.

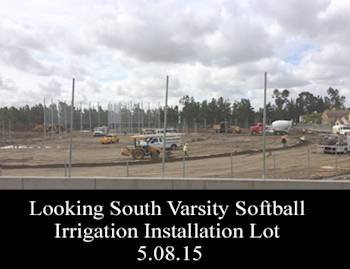

All irrigation and sod has been installed in all 4 fields. Flatwork at the playfields is complete. All scoreboards have been installed. All fencing and gates have been installed in the playfields. Structural steel and decking are almost complete at concession. Waste and vent piping has started. Track curb, drainage and grading has started. Bleacher footings have started. Elevator has been installed. Demolition of Y building has begun. Flatwork on the upper field has started and the upper field retaining walls are also underway.

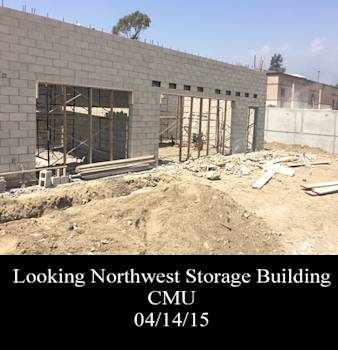

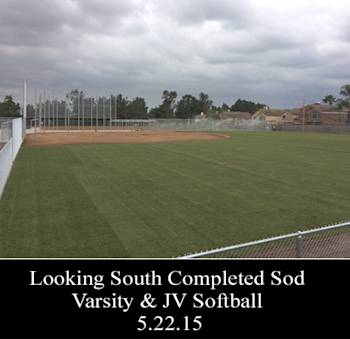

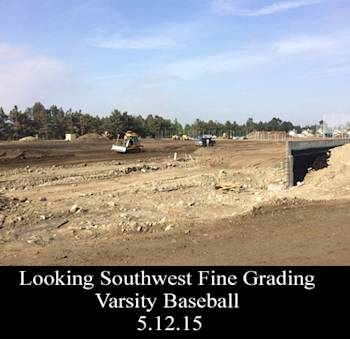

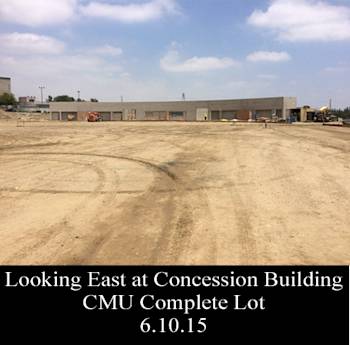

The underground gas and water line were installed to the concession building. The playfield concrete flatwork is progressing. The foul ball poles have been installed for the playfields and the chain link fencing is progressing. The irrigation and soil preparation of for the JV and Varsity Softball fields was completed and the sod was installed in these two fields. The backstop boards were installed in the fields. Fine grading for the parking lot and track and field started. The field cooling for the synthetic field was completed. The roofing for the storage building was completed and the metal stud framing, drywall and plaster was completed. The doors are hung and paint of the interior and exterior is taking place. The concession building CMU walls almost topped out. The demolition of building Y has started. The elevator pit and machine room slab have been poured. The elevator has been placed.

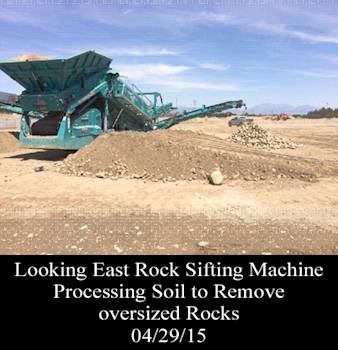

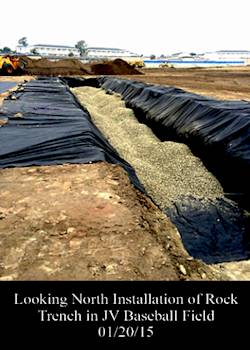

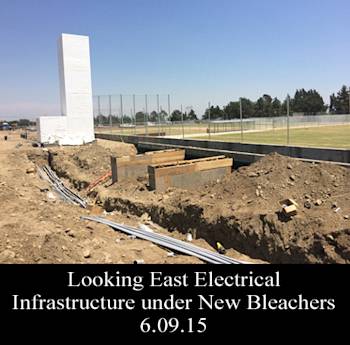

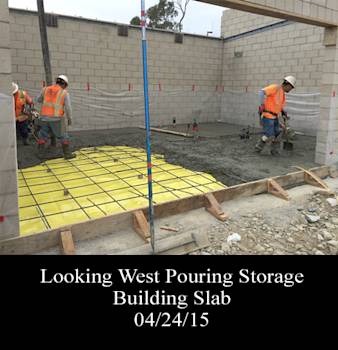

The block walls for the storage building are complete and the structural steel/metal decking has been installed. The block walls for the concession building are is in progress and the slabs inside the concession are progressing through the structure. The concrete flatwork outside the storage building has been poured. The backstop post and chainlink fencing has been installed for all 4 fields. Perimeter chainlink fencing has been installed on the south and west property lines. The irrigation main line is complete in the playfields. The dugout posts have started to be placed. The water lines, electrical infrastructure and storm drain systems for the playfields are all complete. The onsite soil is currently being sifted to remove rocks out of the dirt to create a suitable topsoil to lay sod.

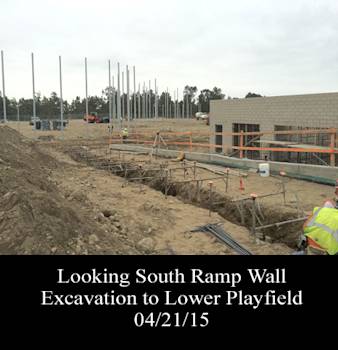

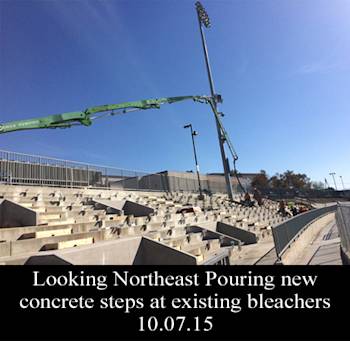

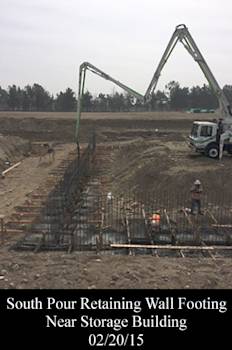

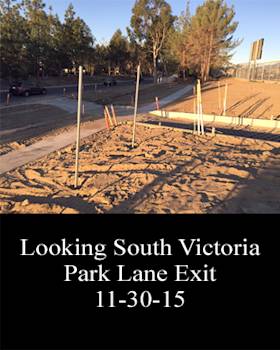

The concrete contractor is continuing to form and pour the retaining walls onsite. The underground utilities in the playfields and near the concession building are being installed. The backstop posts in the playfields began along with the perimeter fencing and playfield chain-link fencing. The storage building footings were poured and the block has started. The concession building underground plumbing was installed and the footings were excavated and rebar was installed. Demolition of the existing bleacher for the Musco poles and new ADA seating is completed. new parking lot started this month.

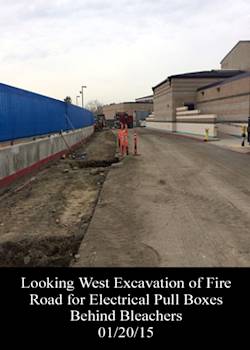

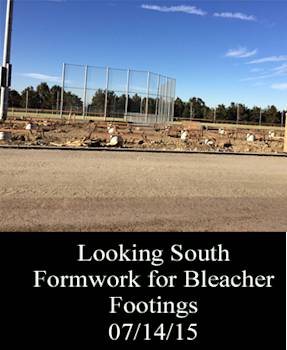

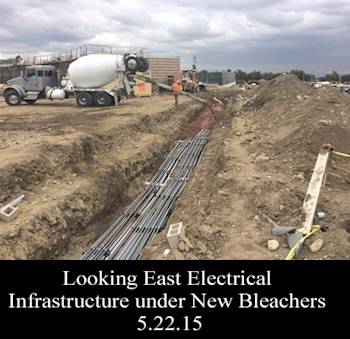

The grading and demolition contractor completed the rough grading of the baseball fields and stadium. The bio swales in the baseball and softball fields were completed. The electrical infrastructure in the fire road was completed and asphalt was put back on the road. The electrical infrastructure for the new stadium began. Demolition of the existing concrete bleachers for the new ADA seating and new Musco stadium lighting began. The concrete contractor mobilized onsite and began the new retaining wall footing excavations, footing rebar and wall formwork for the wall that splits the upper and lower field. The plumbing contractor installed and backfilled the new sewer main line along the new concession building and began installation of the 18” main Storm Drain line that will travel to the parking lot from the stadium field.

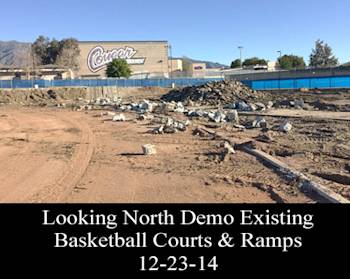

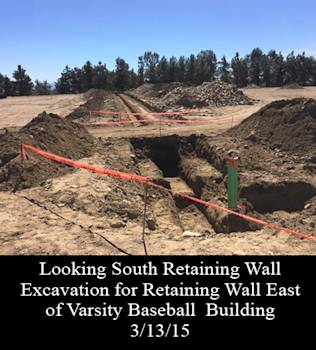

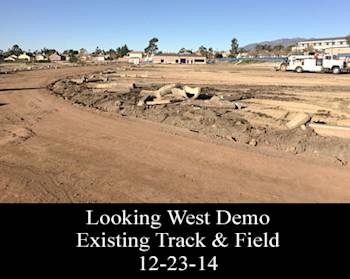

The grading and demolition contractor completed demolition of the old fields, stadium and basketball courts. Rough grading began on the fields and track areas. Over excavation of the soil under the retaining walls and new buildings began. Installation of the new electrical infrastructure began in the fire access road.

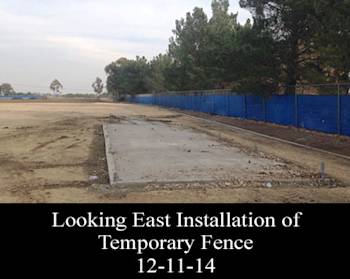

The grading and demolition contractor mobilized this month and began by building the construction entrance. The temporary construction fencing was installed at the perimeter of the construction site. The grass was stripped from the athletic fields and hauled off. Demolition was completed at the basketball courts, Track & Field, behind the weight room, sport field fencing, pitcher mounds, and dugouts. Demolition of the existing stadiums began on the east and west of the existing bleachers.
